JORDAN HYDROELECTRIC PLANT INSTALLATION WORK WEEKS OF 9-19 / 10-3, 2011 |
2 UNITS 4.5 MW |
----UNDER CONSTRUCTION----
2- MODULAR KAPLAN TURBINE GENERATOR UNITS
US ARMY CORPS OF ENGINEERS' DAM
---JORDAN DAM INSTALLATION---
Module 1 East bay slot installation

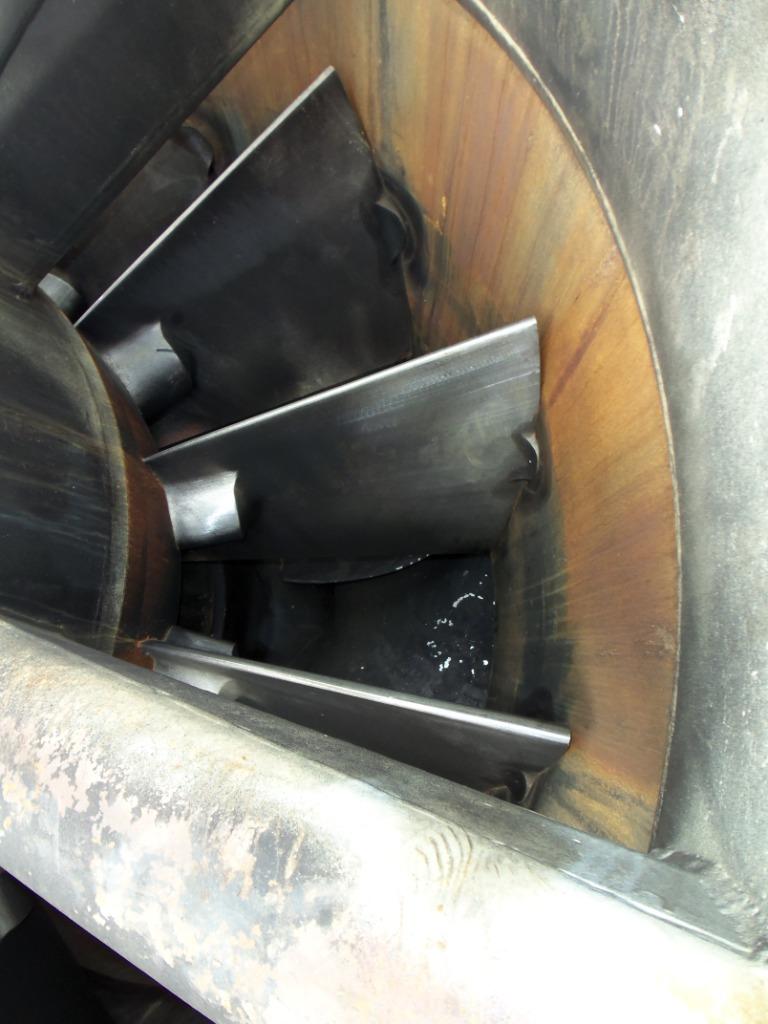

Kaplan turbine runner |

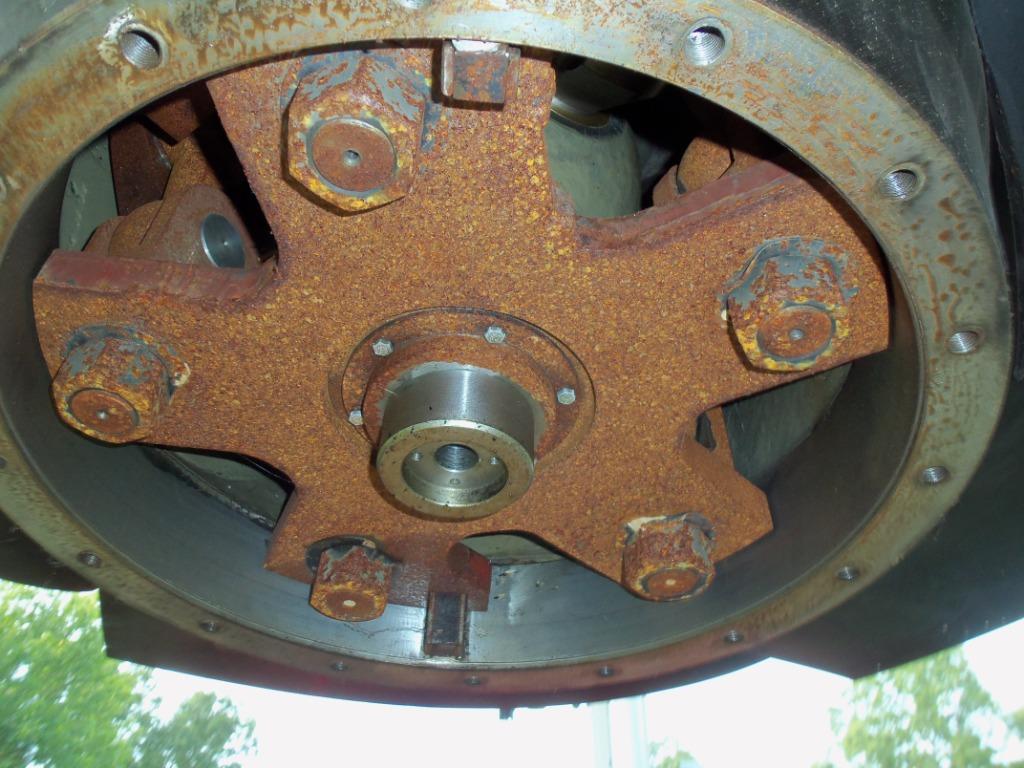

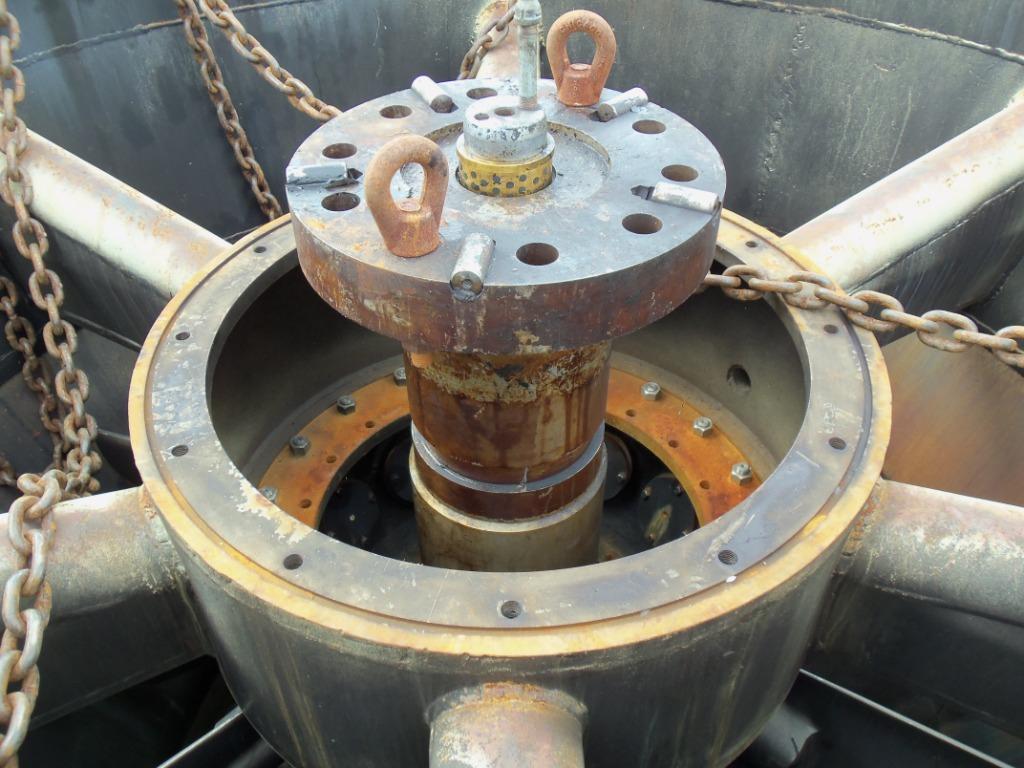

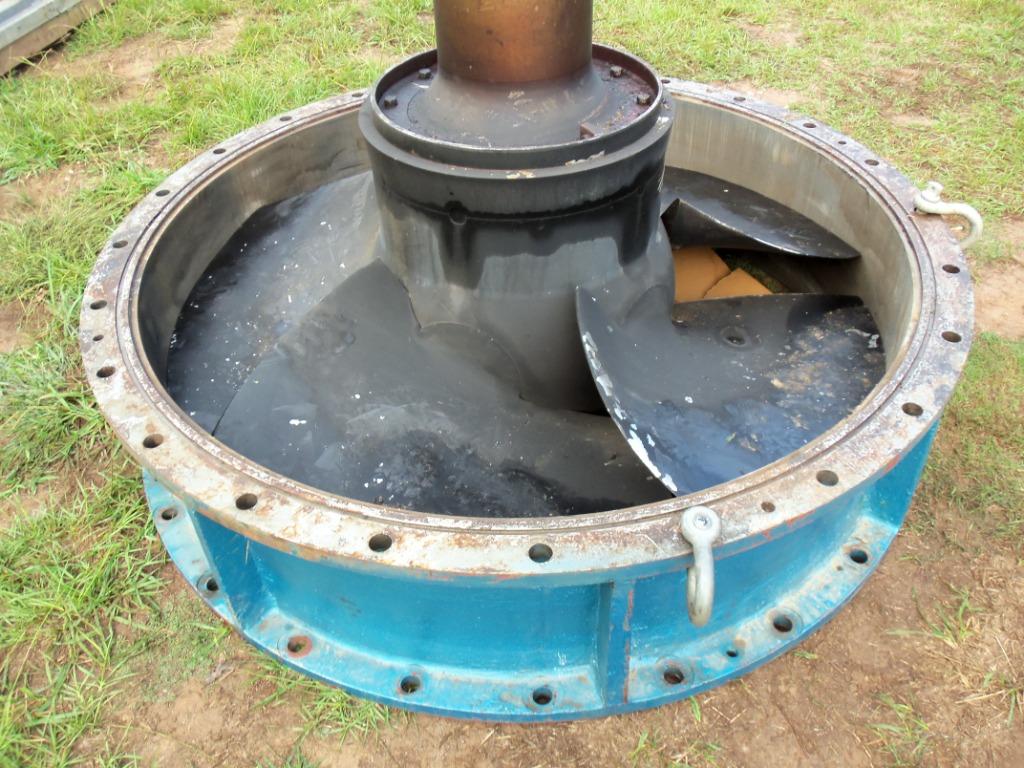

Runner hub |
Runner inside discharge ring |

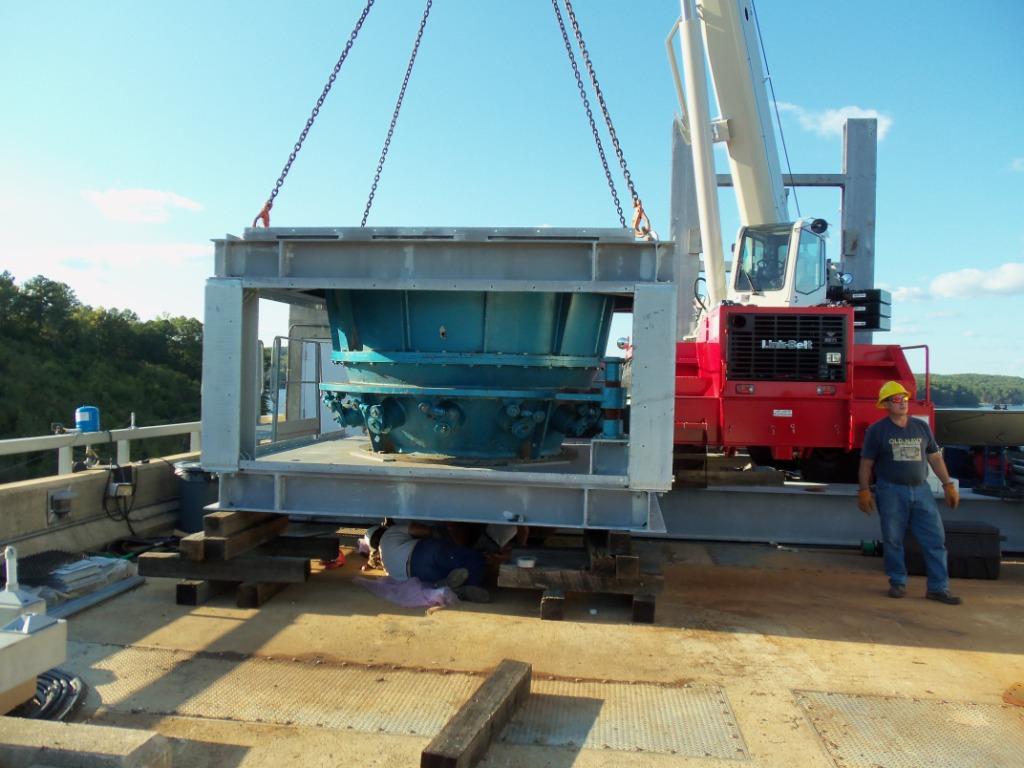

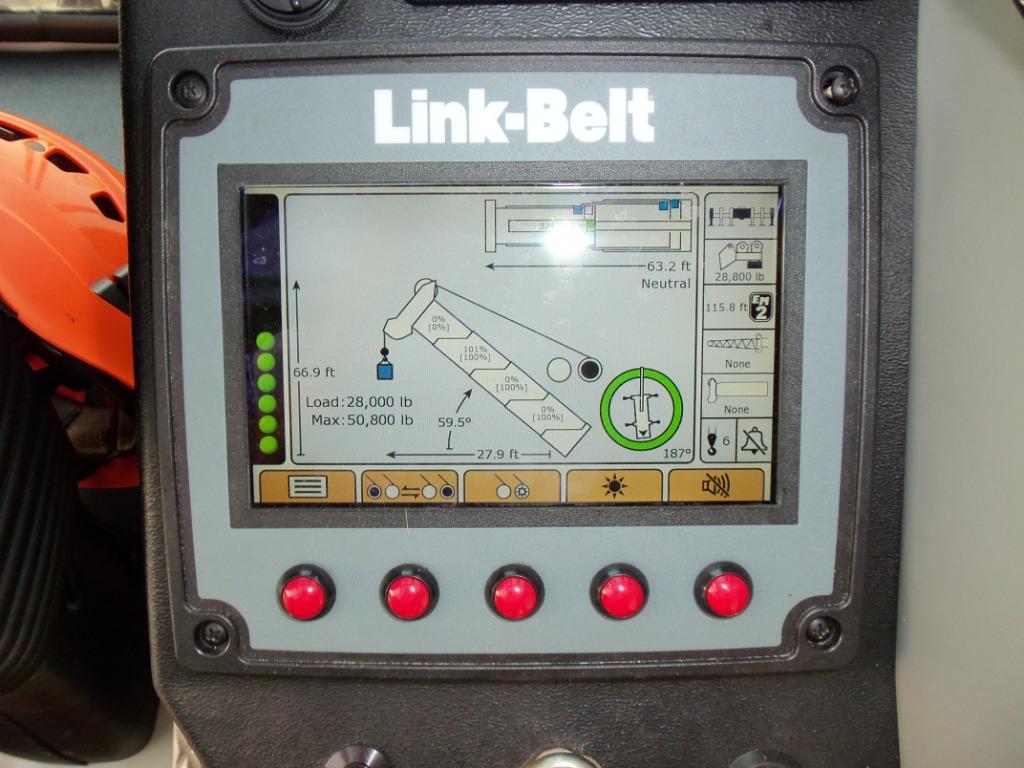

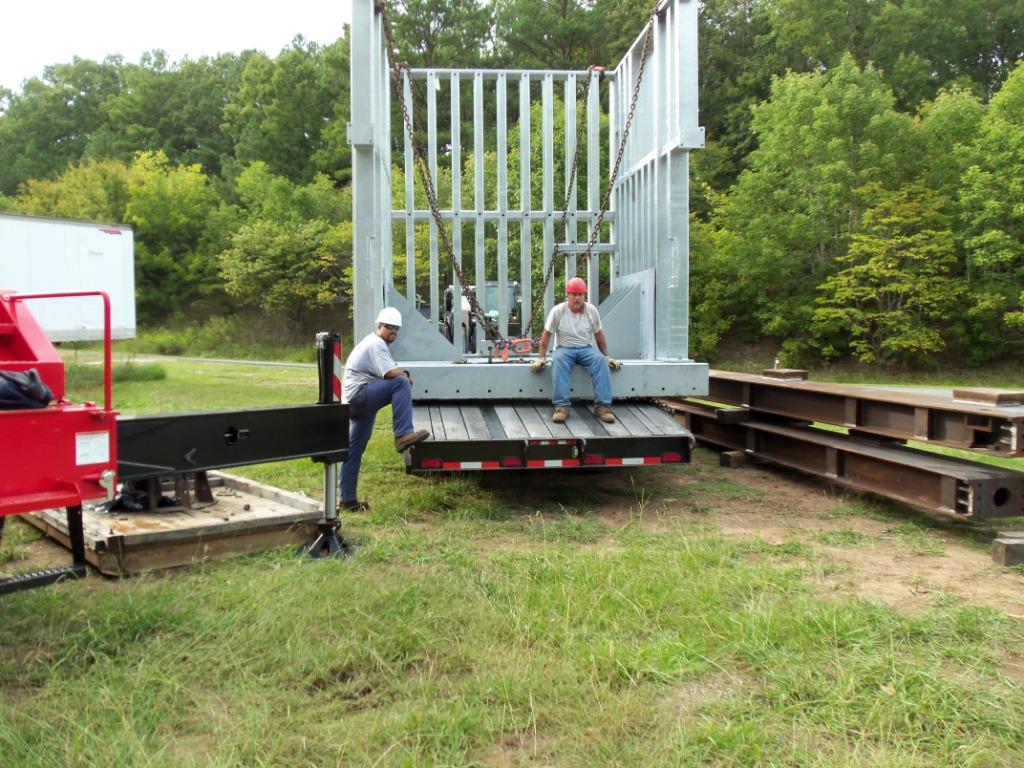

Shark cage loaded on equipment trailer |
|

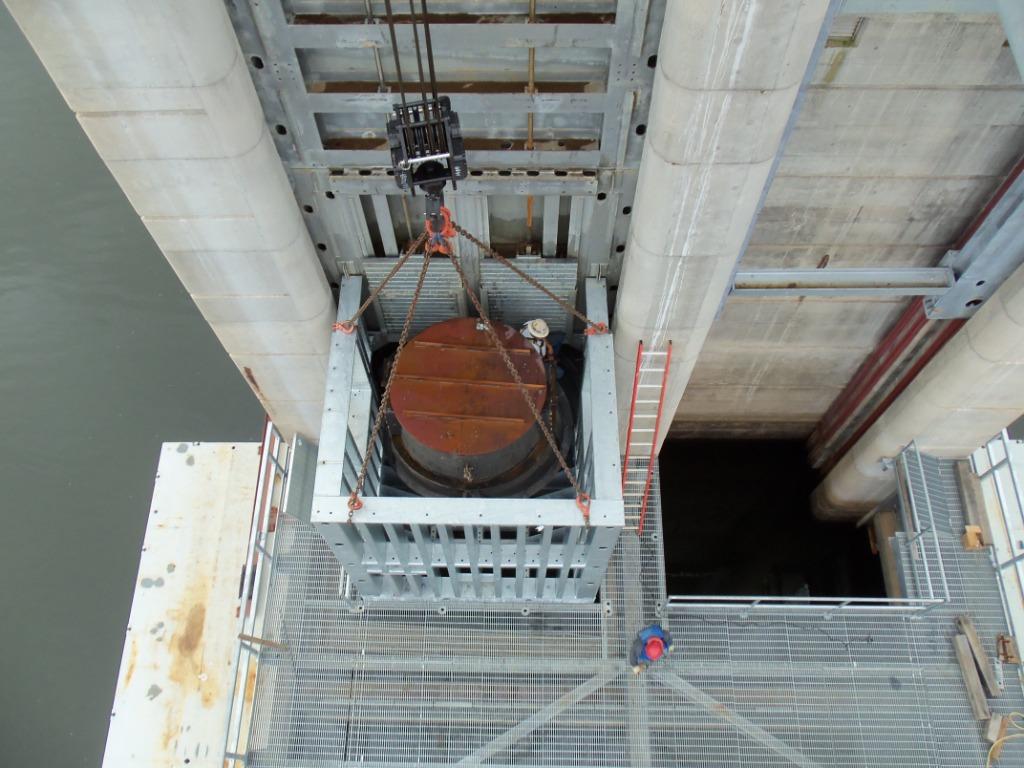

Transport to tower roof |

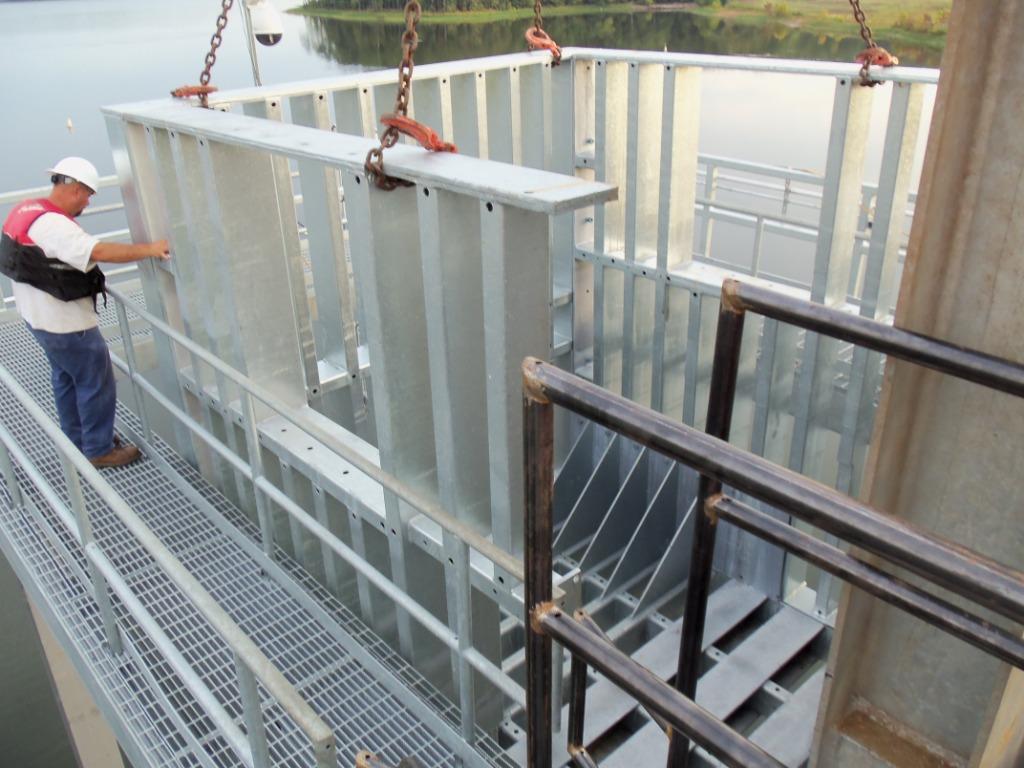

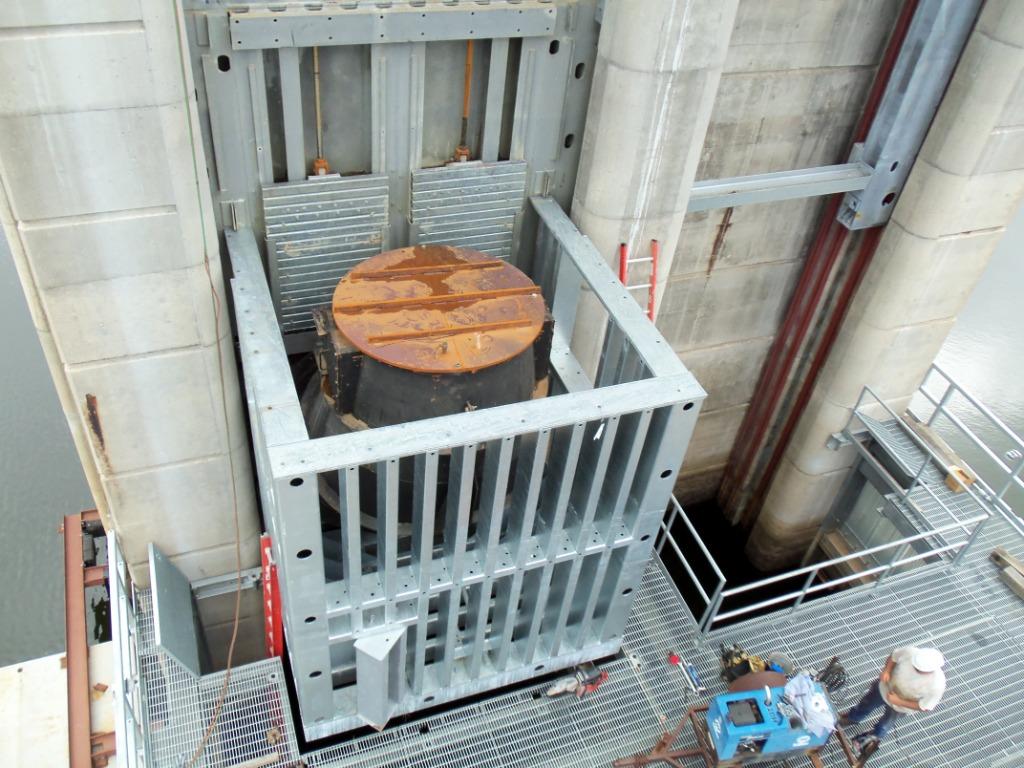

Shark cage upstream, sides and bottom |
28,000 pounds |
|
|

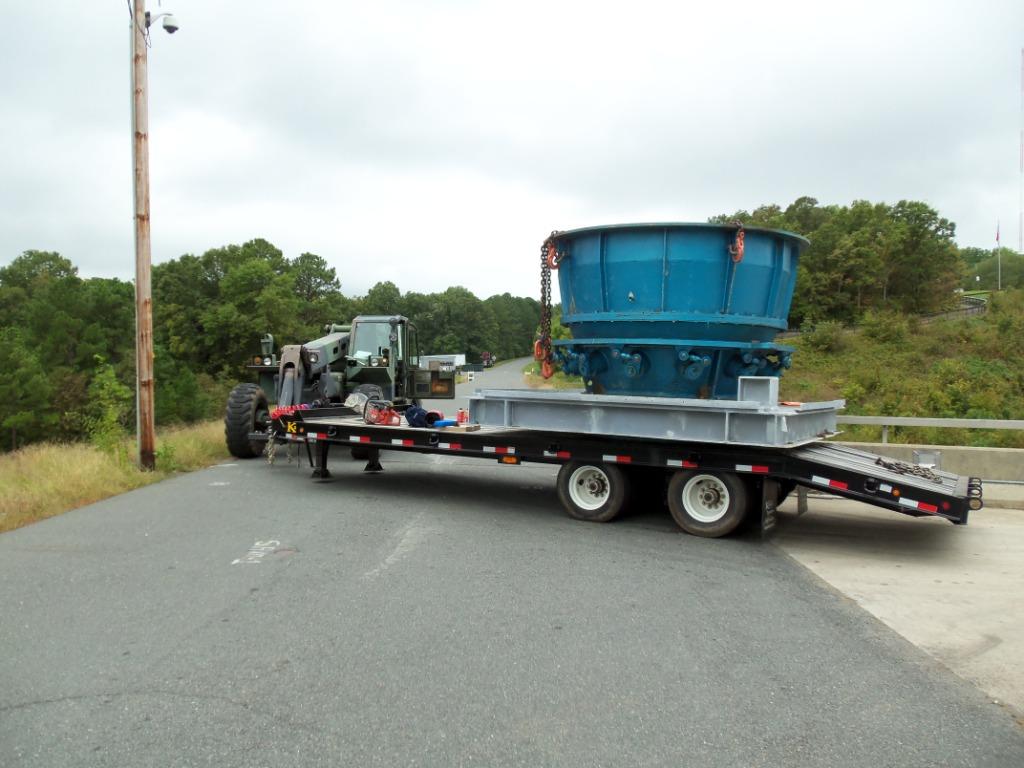

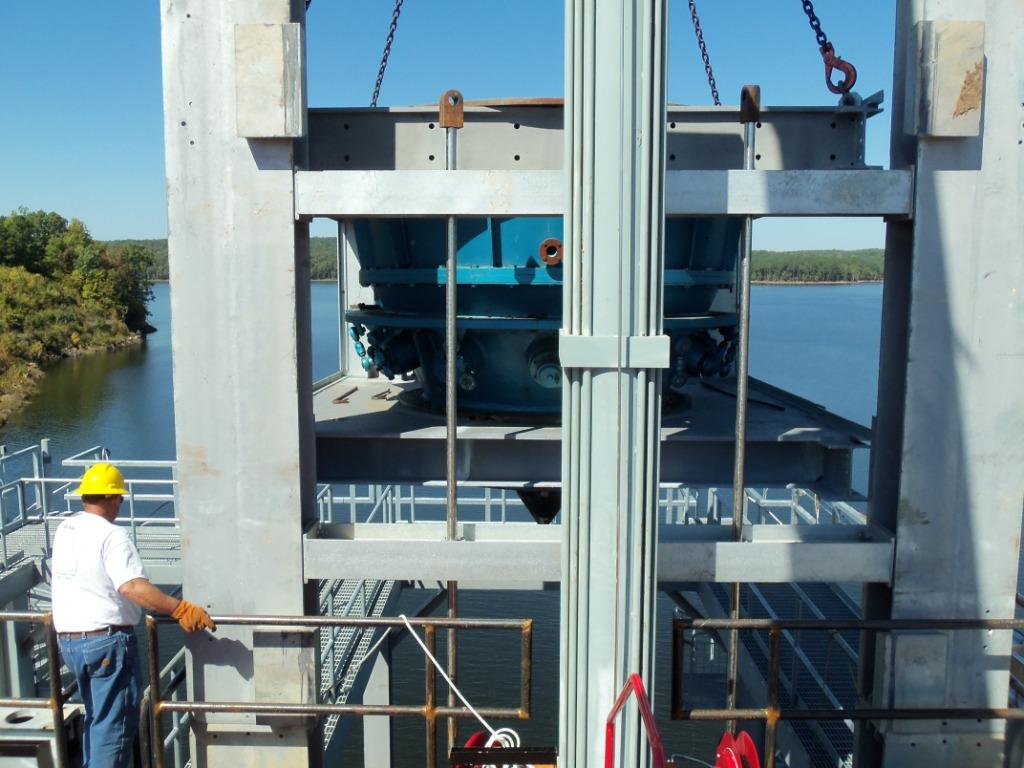

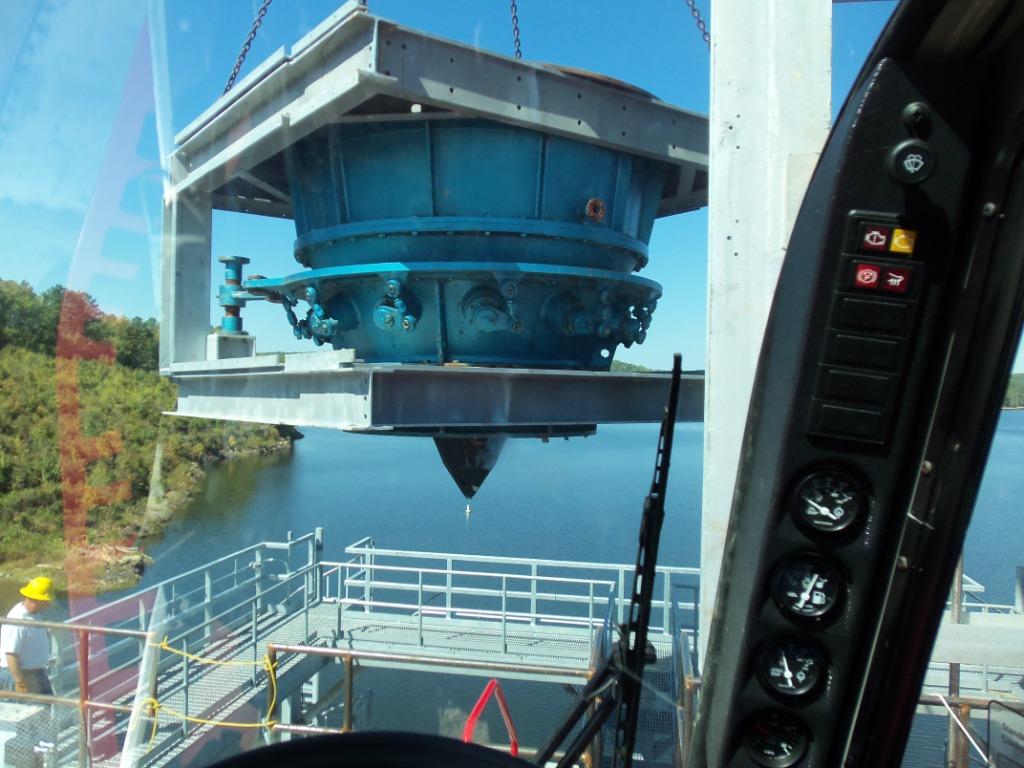

Turbine components transported to tower |

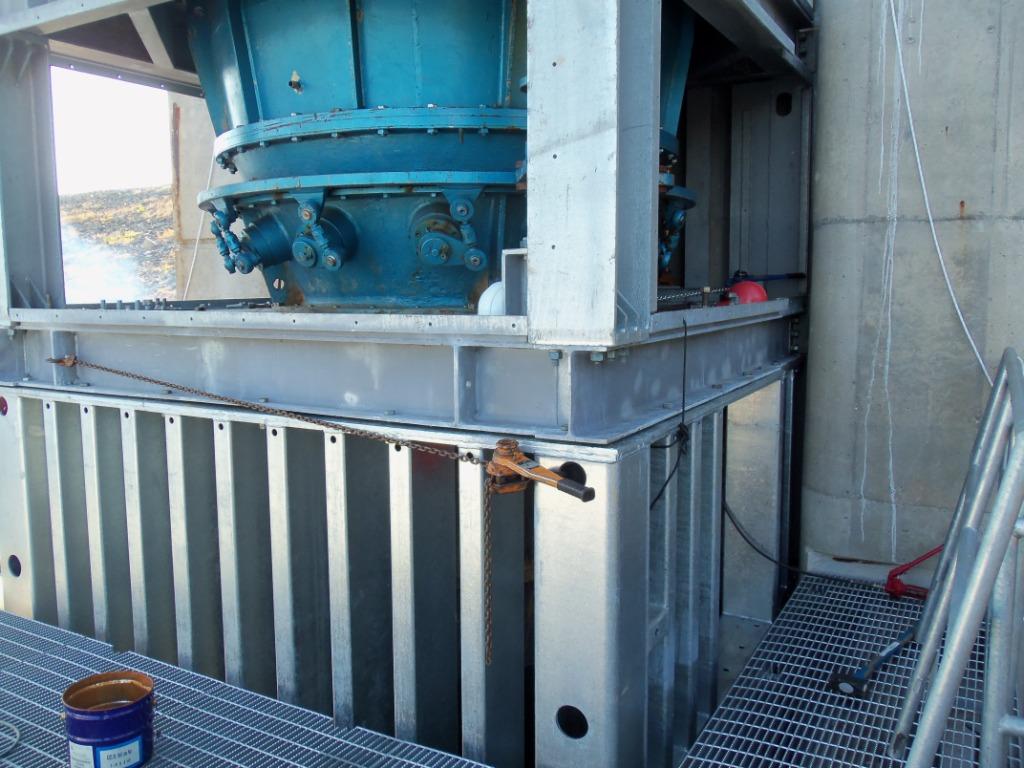

Distributor with wicket gates |
Runner shaft coupling with hydraulic ports |
|

Underside of headgate section showing bottom rubber seal |

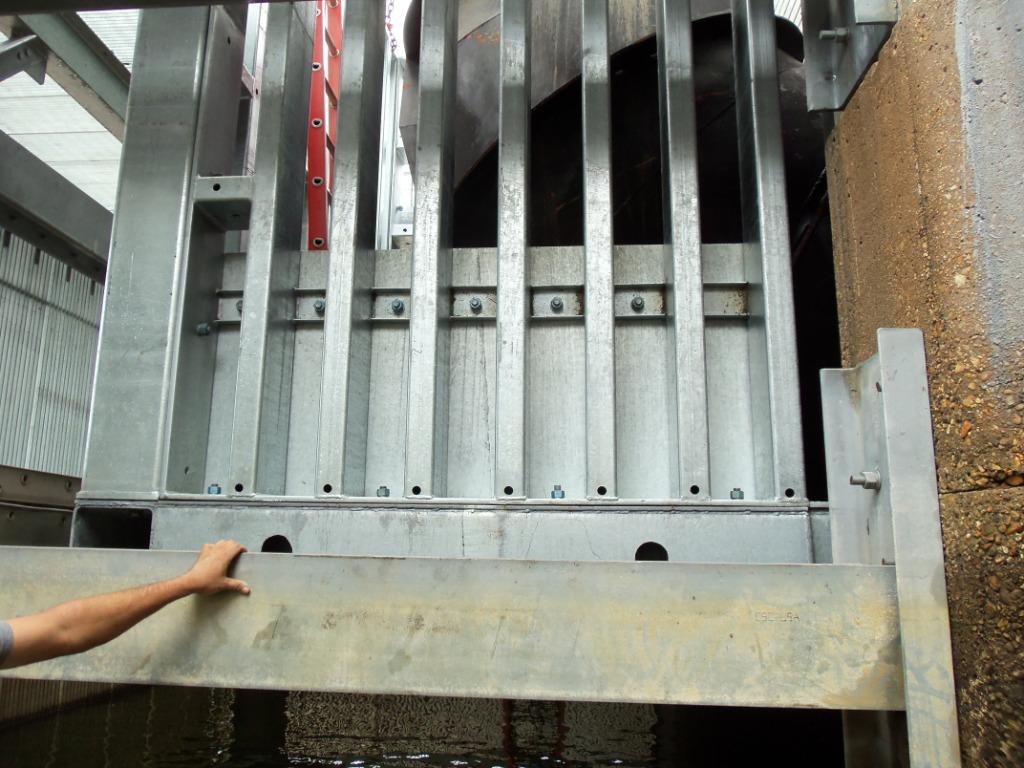

East front water quality gate opening |

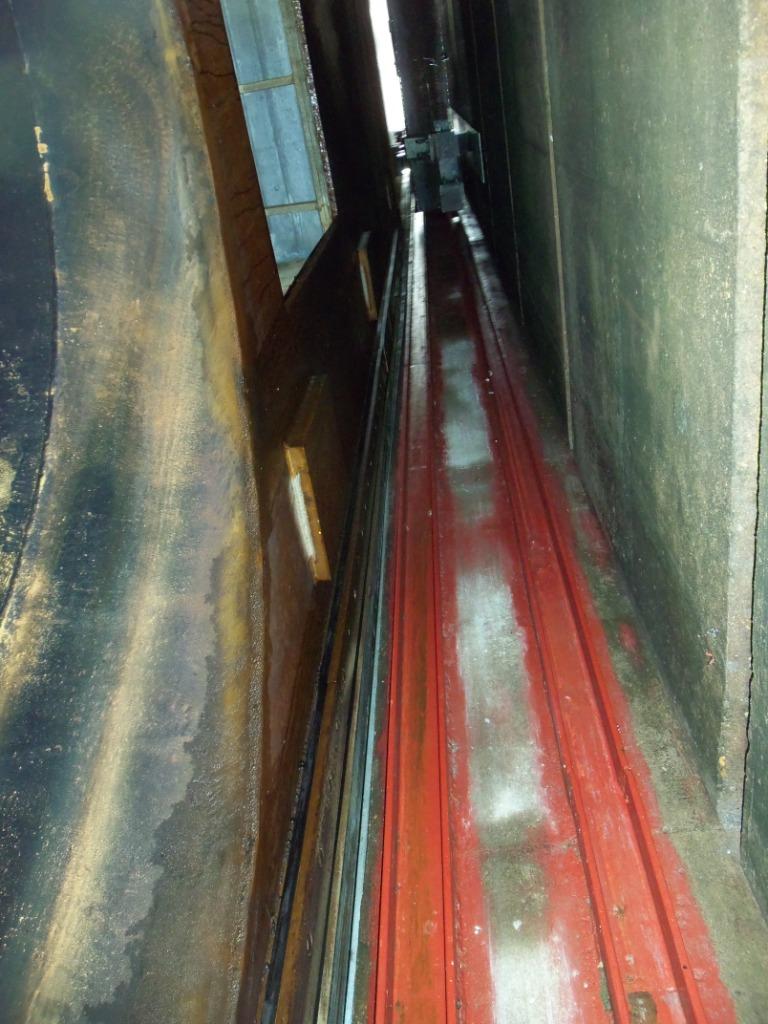

Downstream face of module interface with stoplog slot - viewed from boat |
|

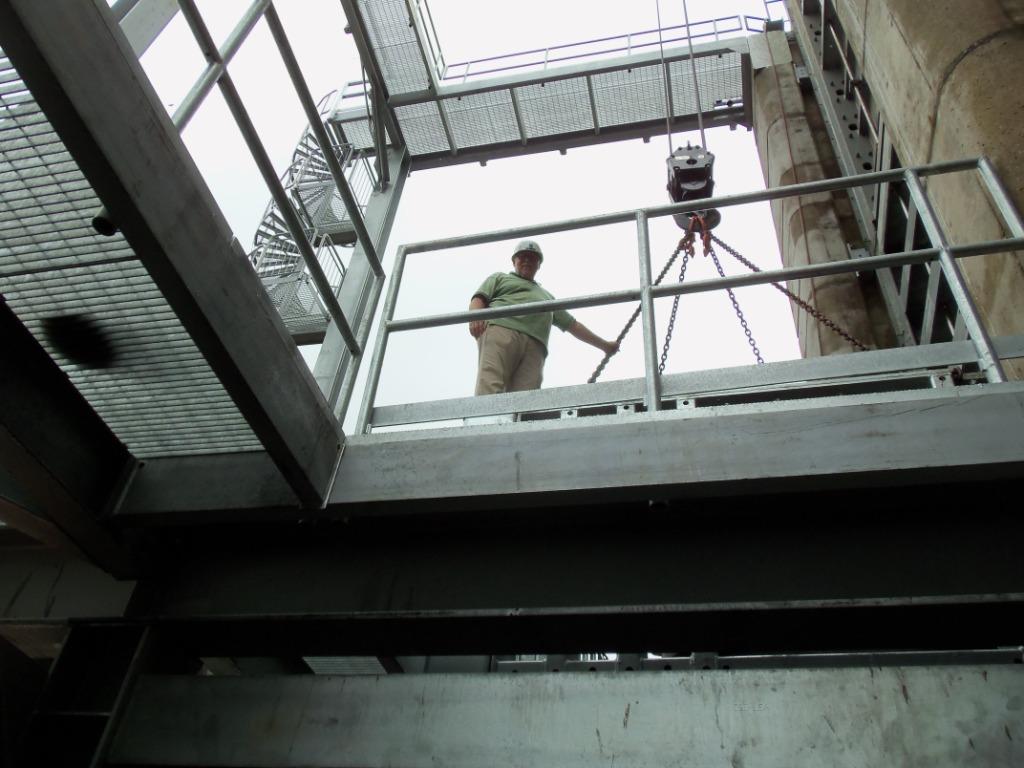

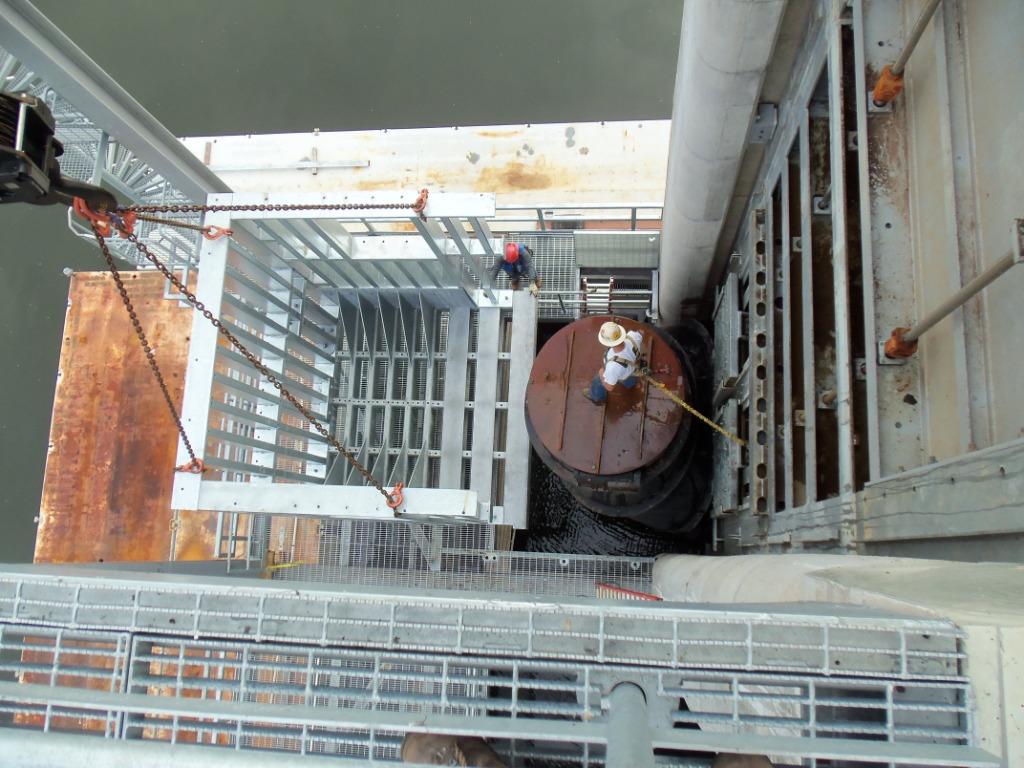

Lift carriage viewed from boat
|

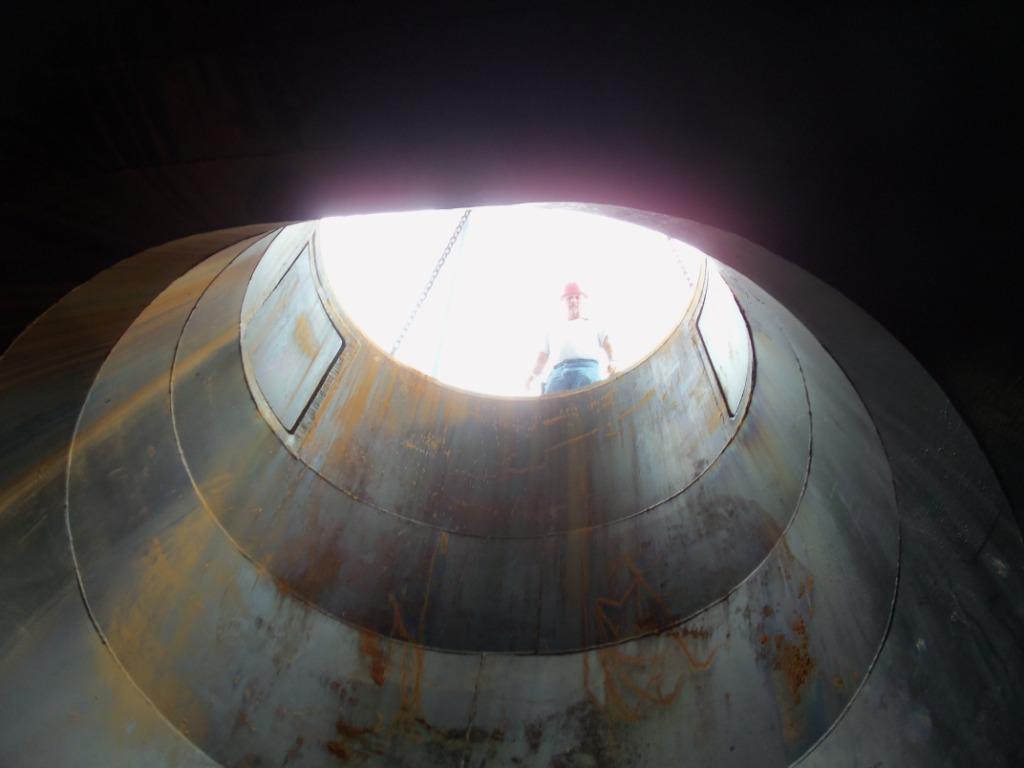

Looking up drafttube from boat |
Carriage |
|
|
|

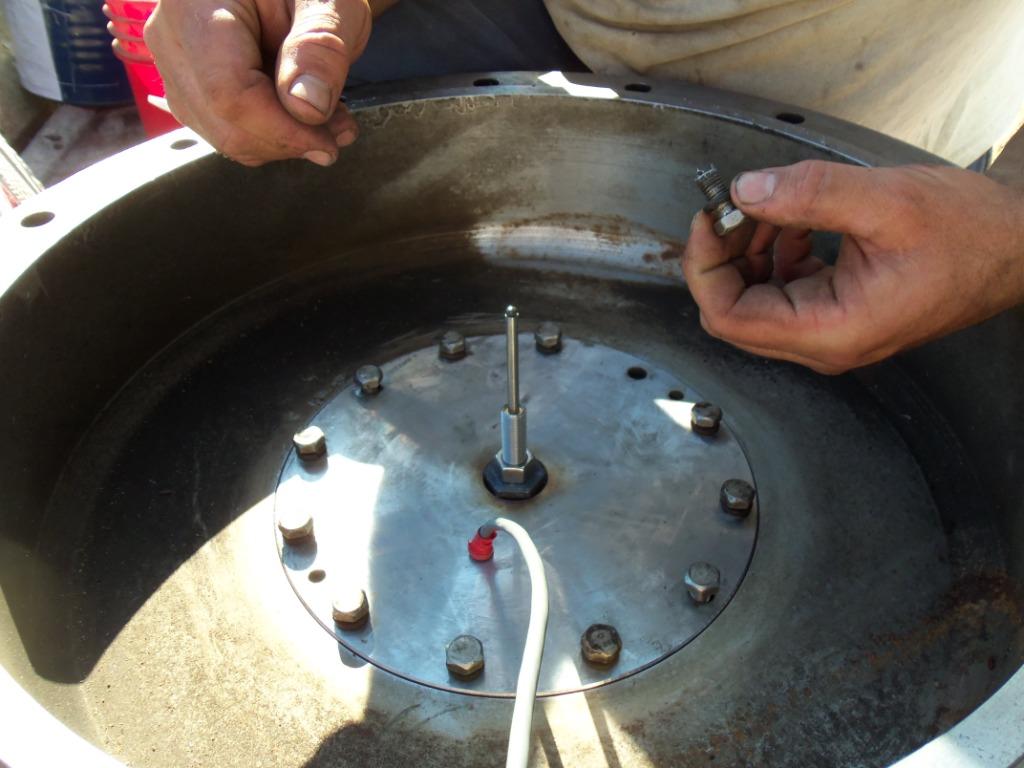

Runner blade angle LVDT sensor |

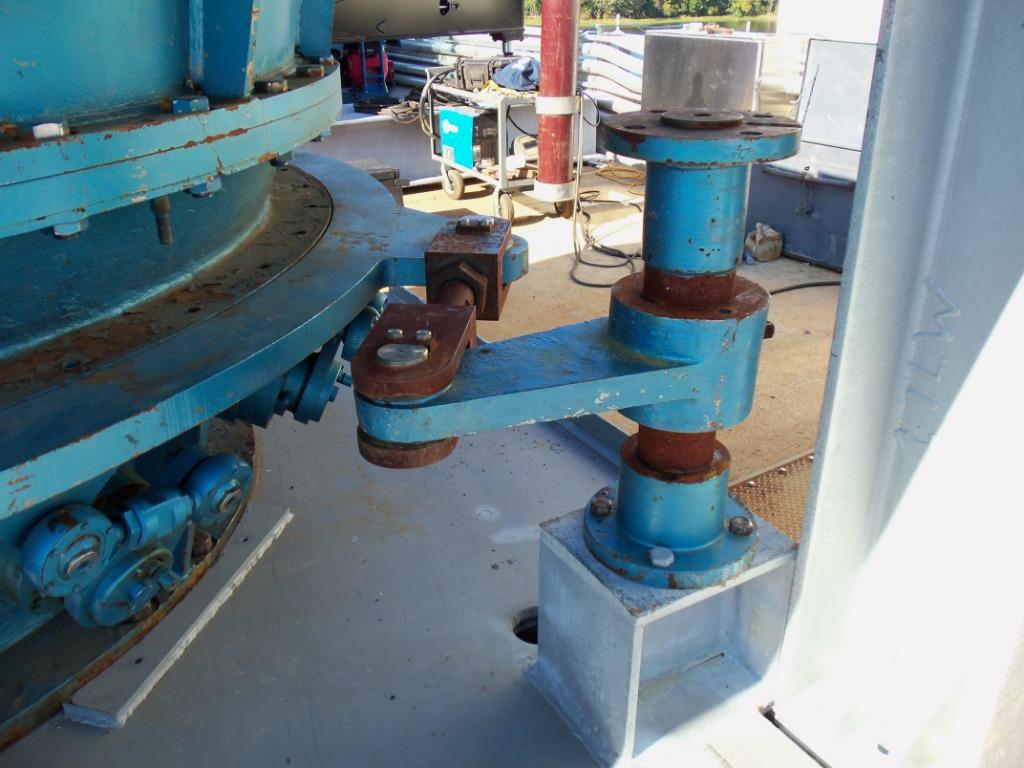

Wicket gate operator shaft |

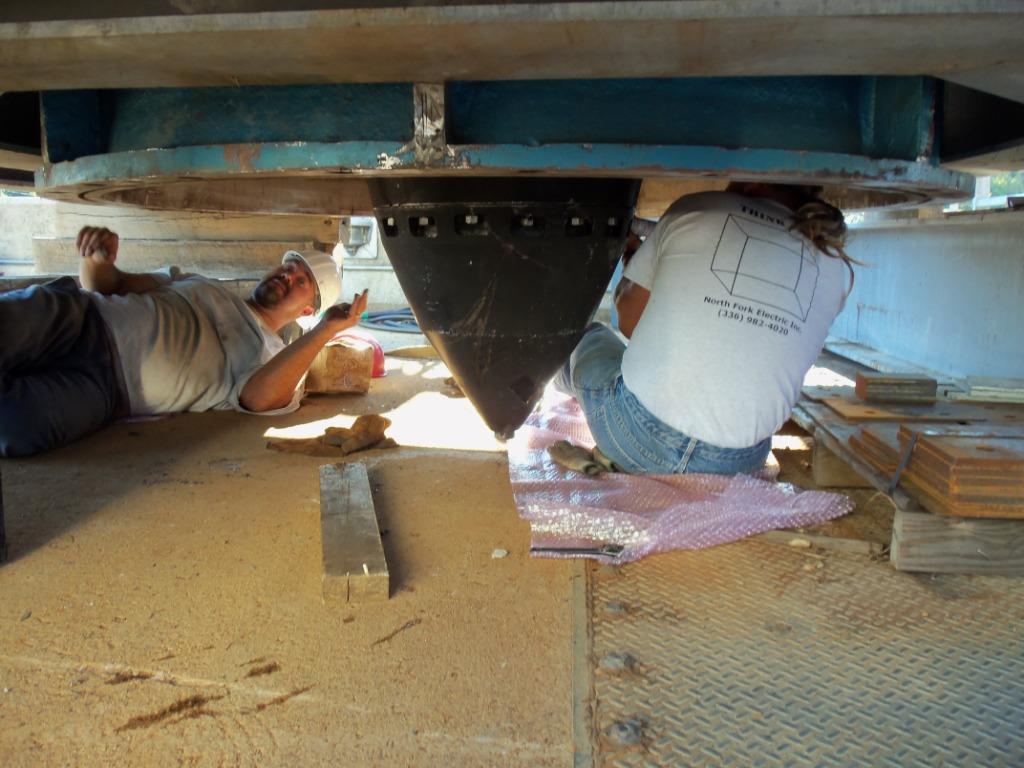

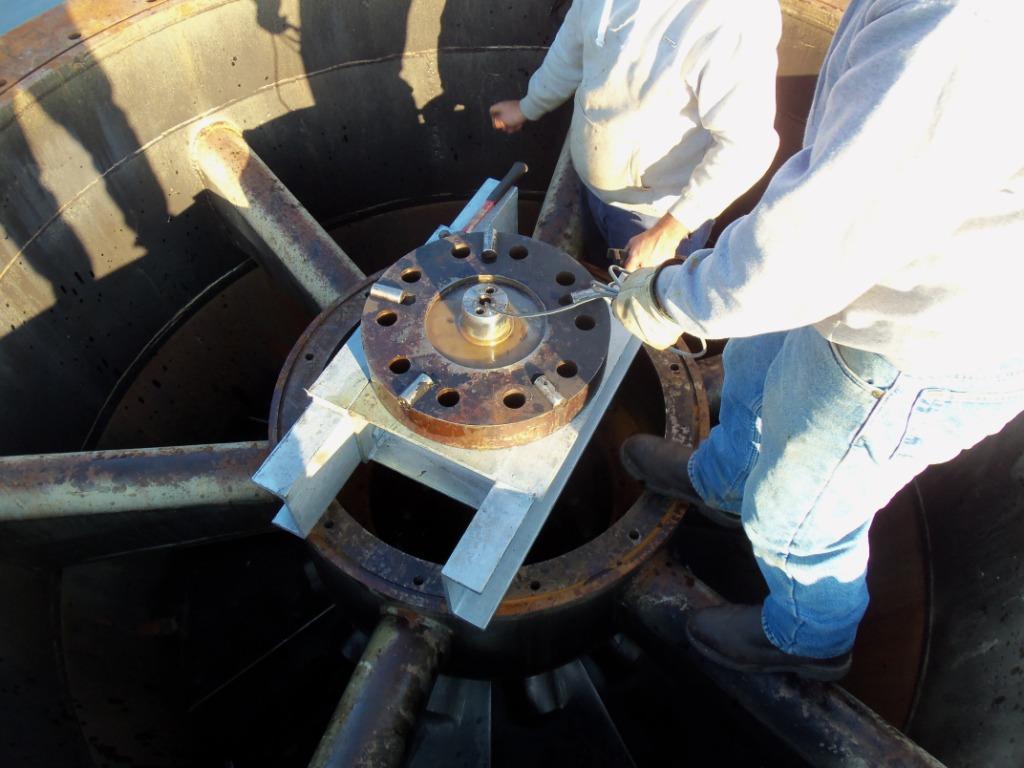

Installing runner nosecone |
Runner support jig |

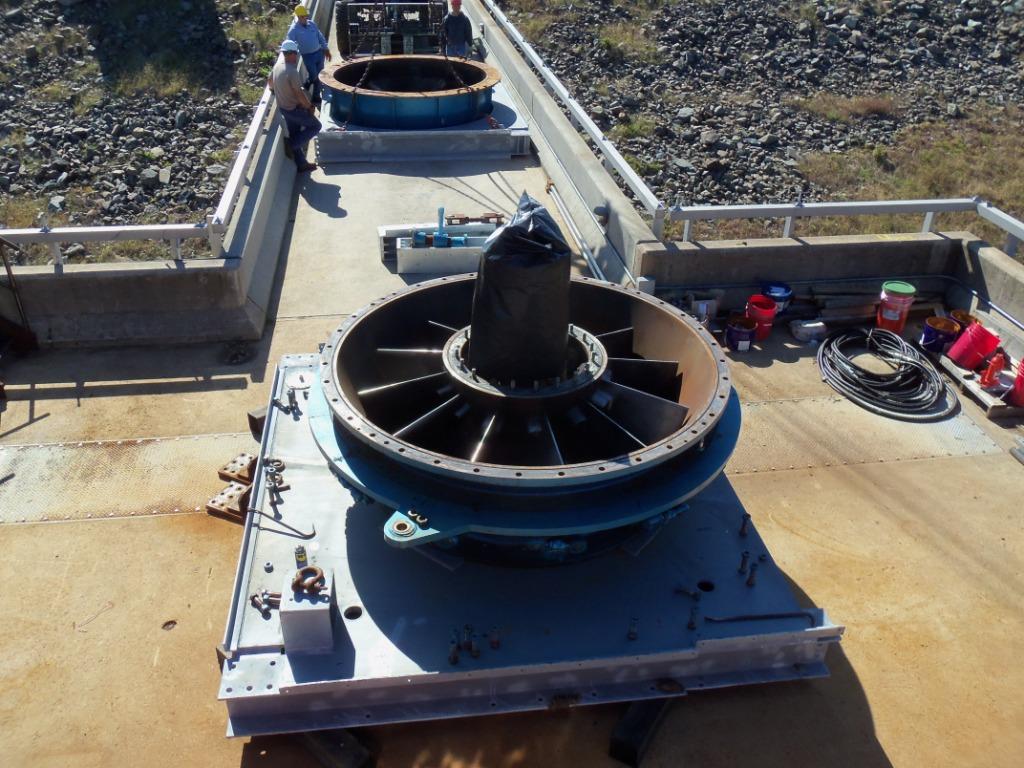

Lower turbine section assembly |
|
|
Rope access / fall protection
