JORDAN HYDROELECTRIC PLANT INSTALLATION WORK WEEKS OF 8-15/22-11 |
2 UNITS 4.5 MW |
----UNDER CONSTRUCTION----
2- MODULAR KAPLAN TURBINE GENERATOR UNITS
US ARMY CORPS OF ENGINEERS' DAM
---JORDAN DAM INSTALLATION---

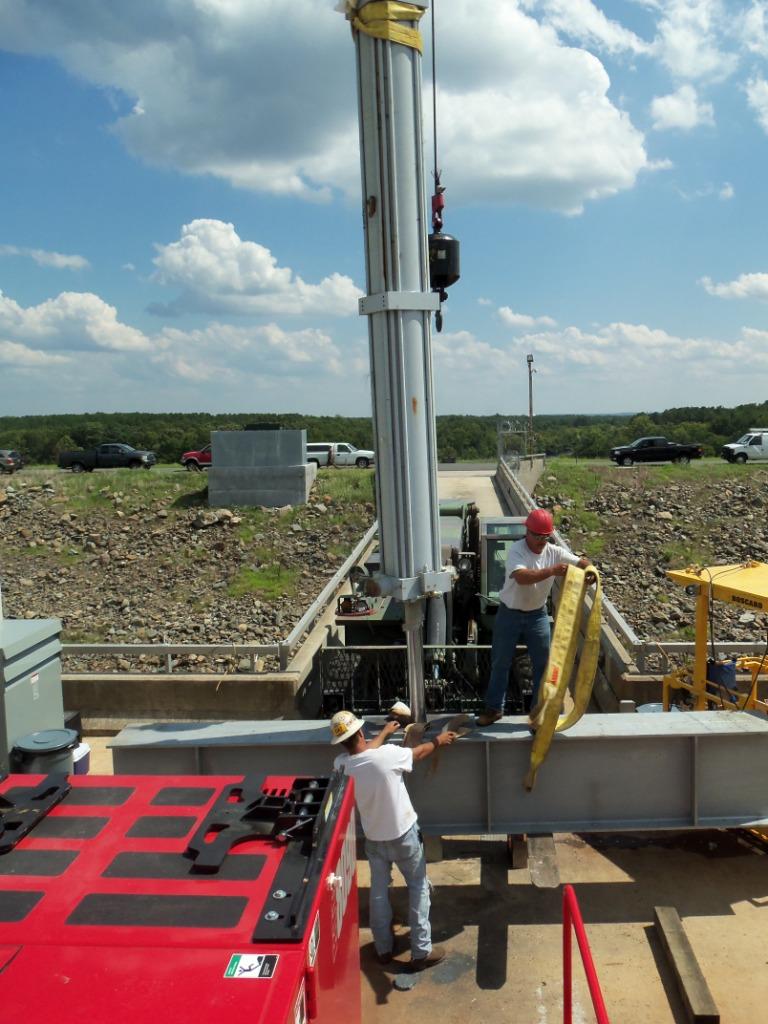

Module 1 Lift Carriage Installation
Weeks of 8-15-11 / 8-22-11
* Note
Carriage is being installed partially plated and not galvanized to test the fit and performance.
After acceptable operation is proven by installing the east side module, the carriage will be removed, completed and galvanized

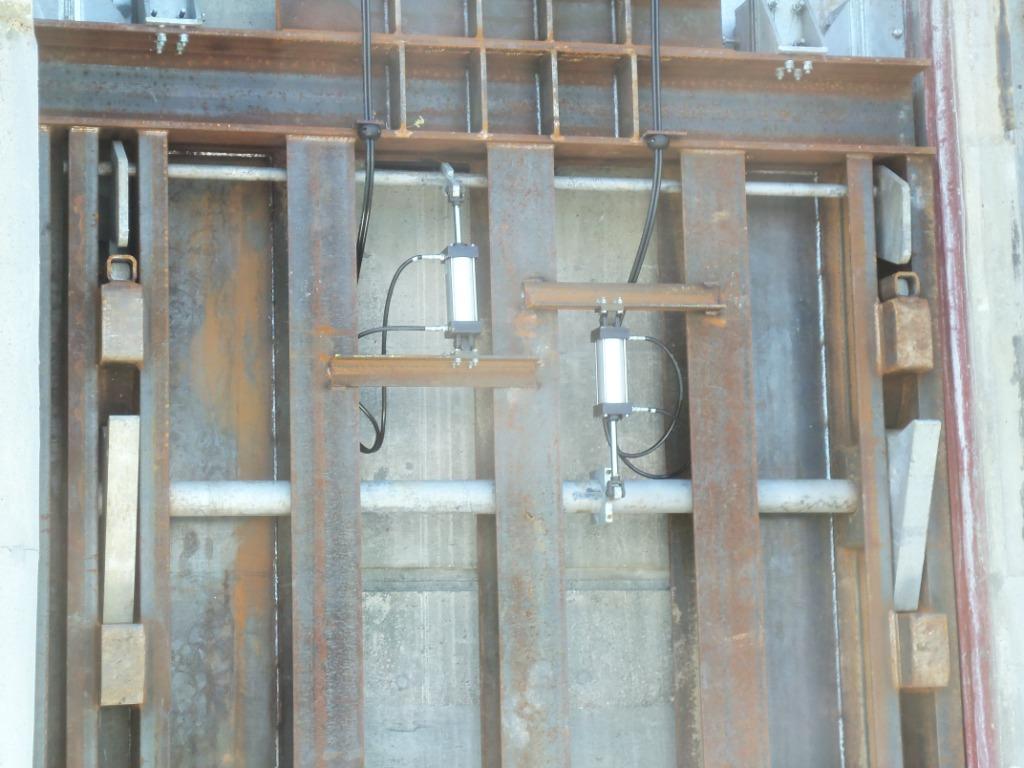

Lift cylinder rod eye / trunnion mounts |

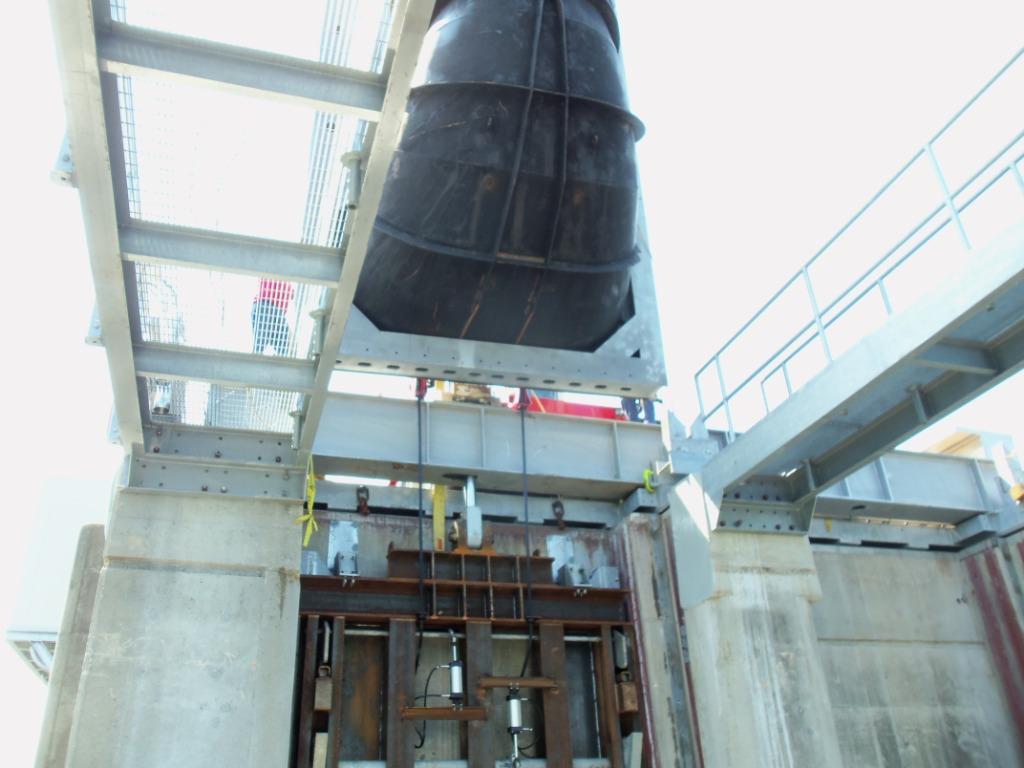

Setting headgate section into east bay slot |
Lift carriage |

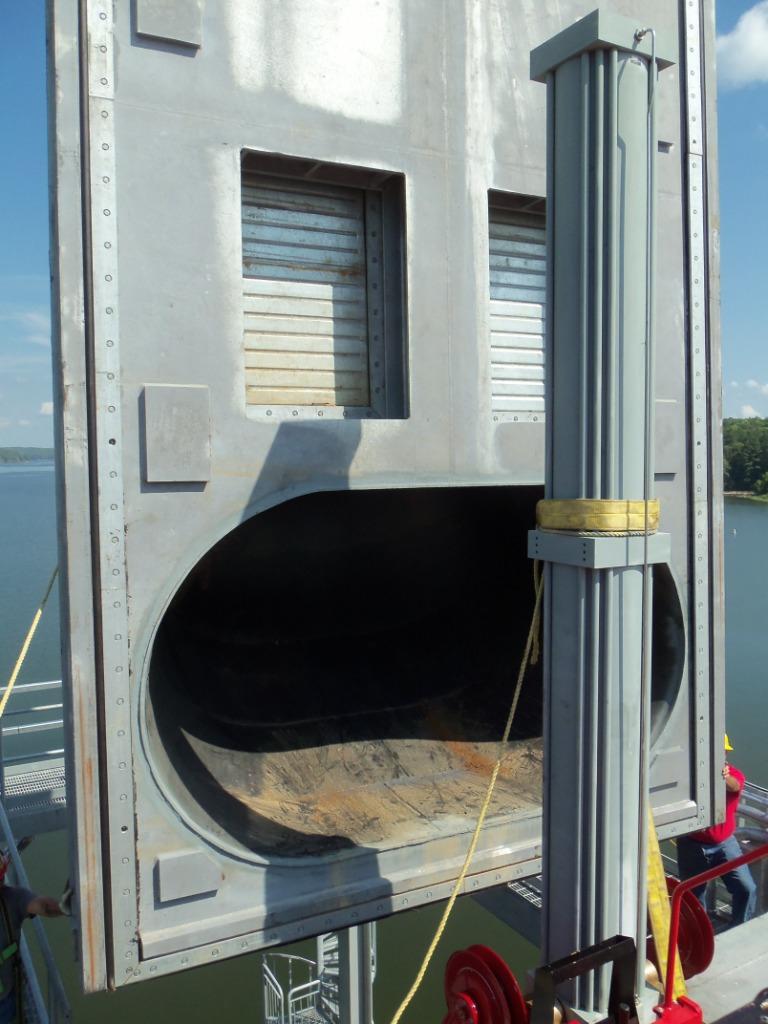

Headgate section |
Weight 58,000 pounds |

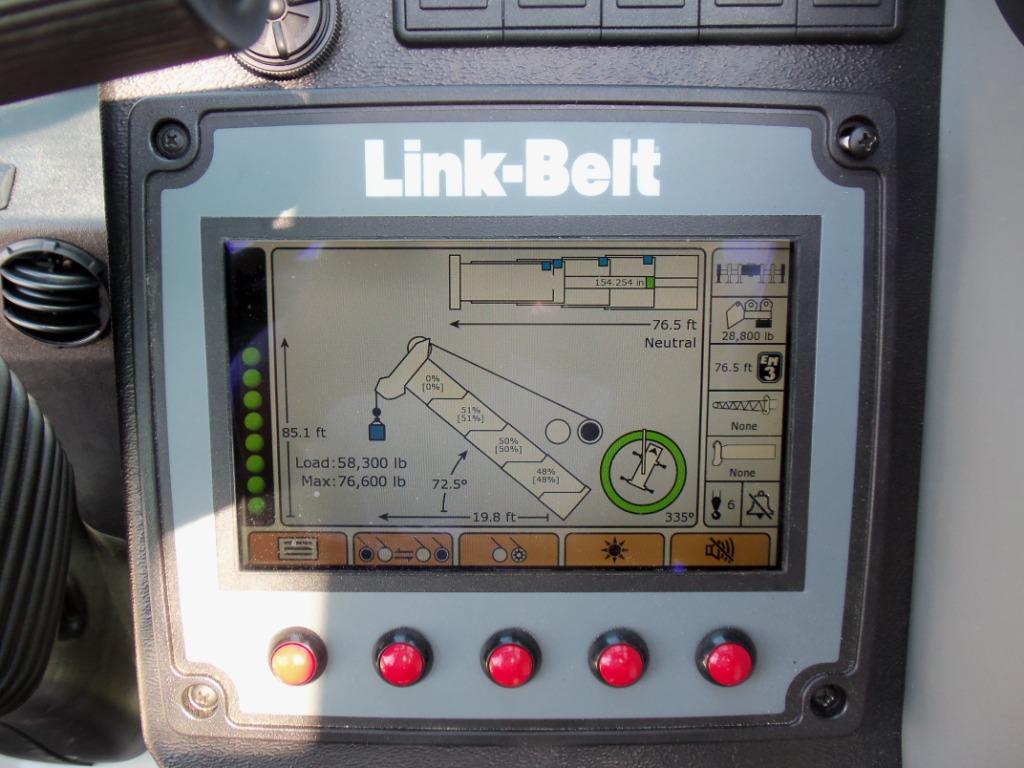

Lift carriage cam operator air cylinders |

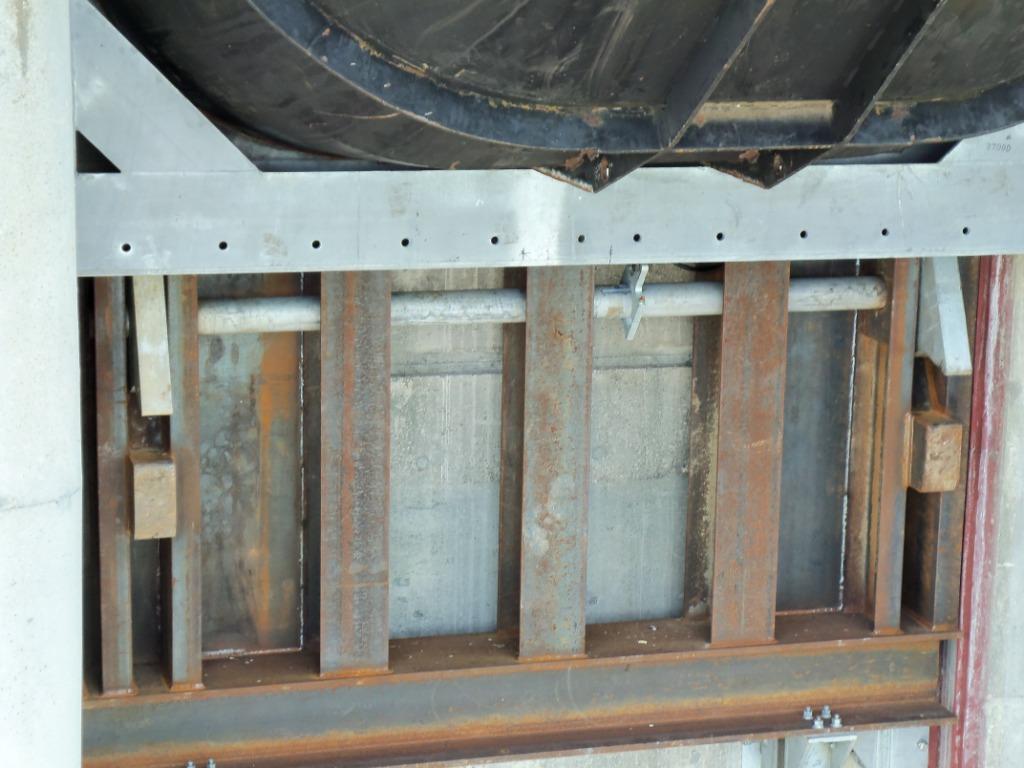

Lower lift cams |
Downstream flume wall |

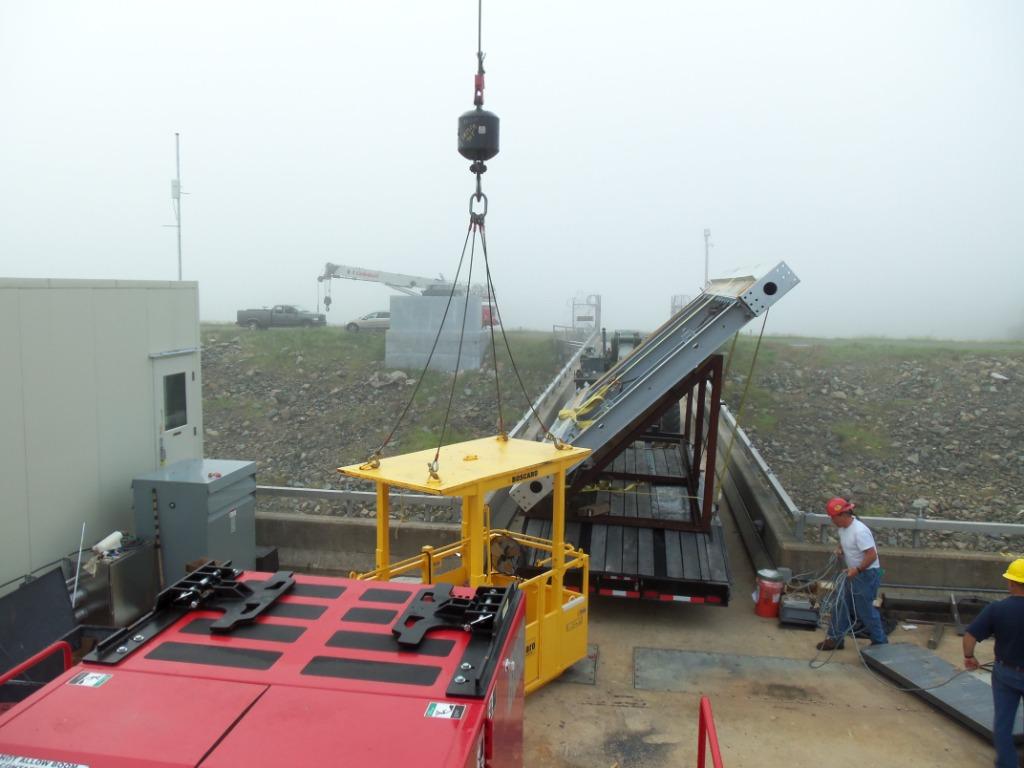

Transport flume wall to tower roof |
