JORDAN HYDROELECTRIC PLANT 90-TON CRANE SETUP |
2 UNITS 4.5 MW |
----UNDER CONSTRUCTION----
2- MODULAR KAPLAN TURBINE GENERATOR UNITS
US ARMY CORPS OF ENGINEERS' DAM
---JORDAN DAM INSTALLATION---
Weeks of 6-20-2011 / 6-27-2011
PLATFORMS |

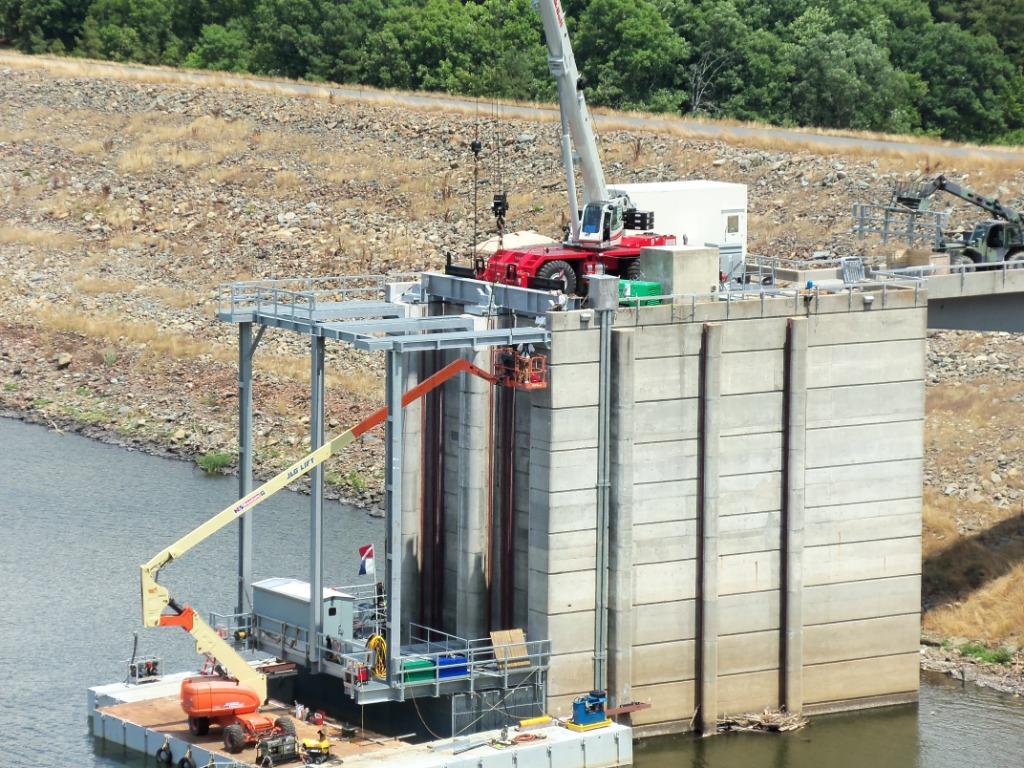

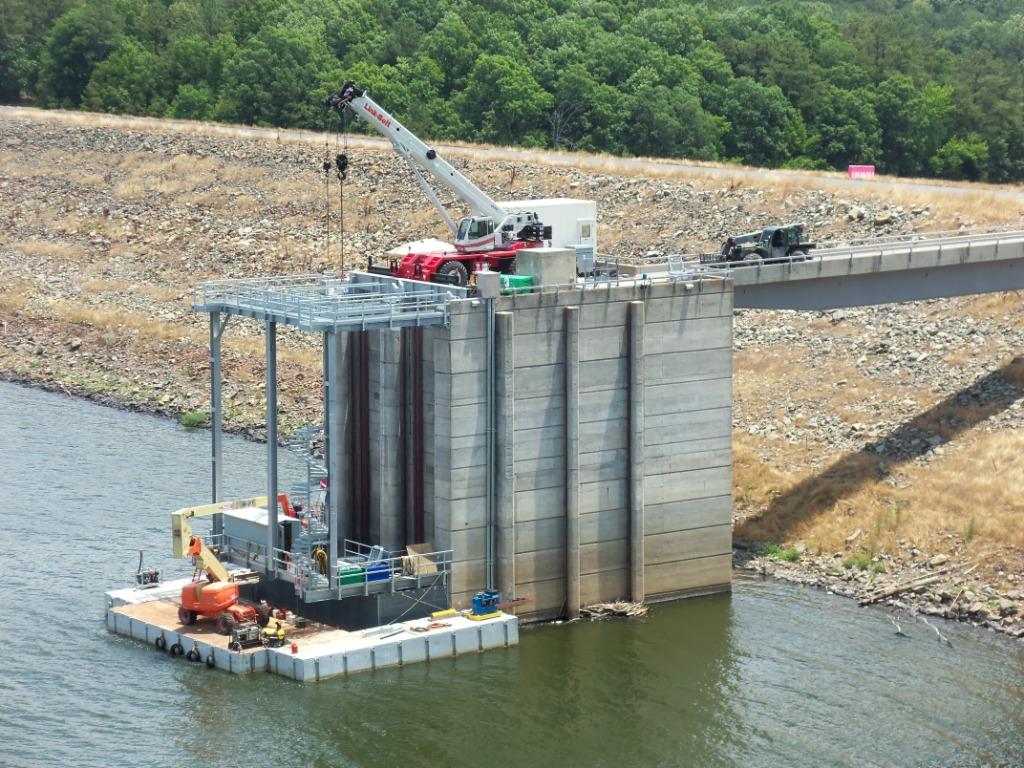

PLATFORMS |

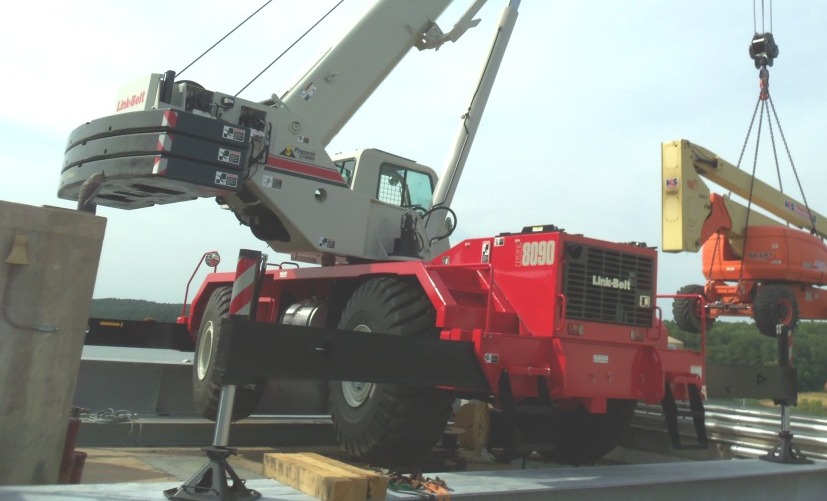

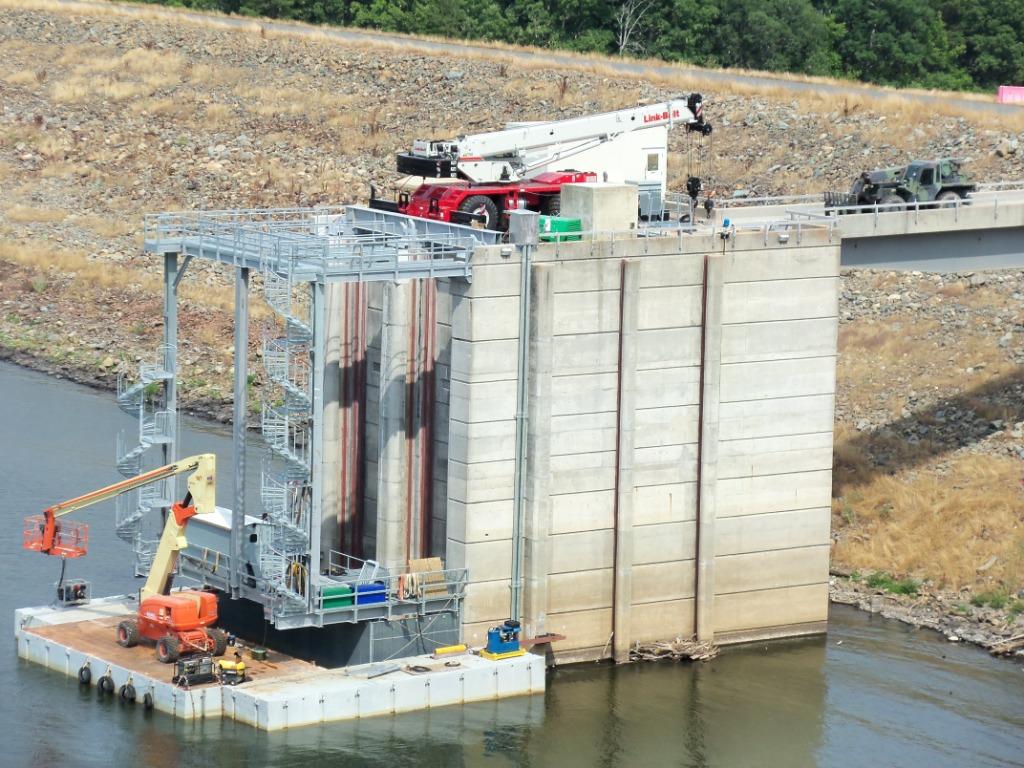

STRIPPED 90-TON LINKBELT RTC 8090 SERIES II DRIVEN ACROSS TOWER ROOF WITH 57.5 DEGREE BOOM FOR 50/50 AXLE LOADING

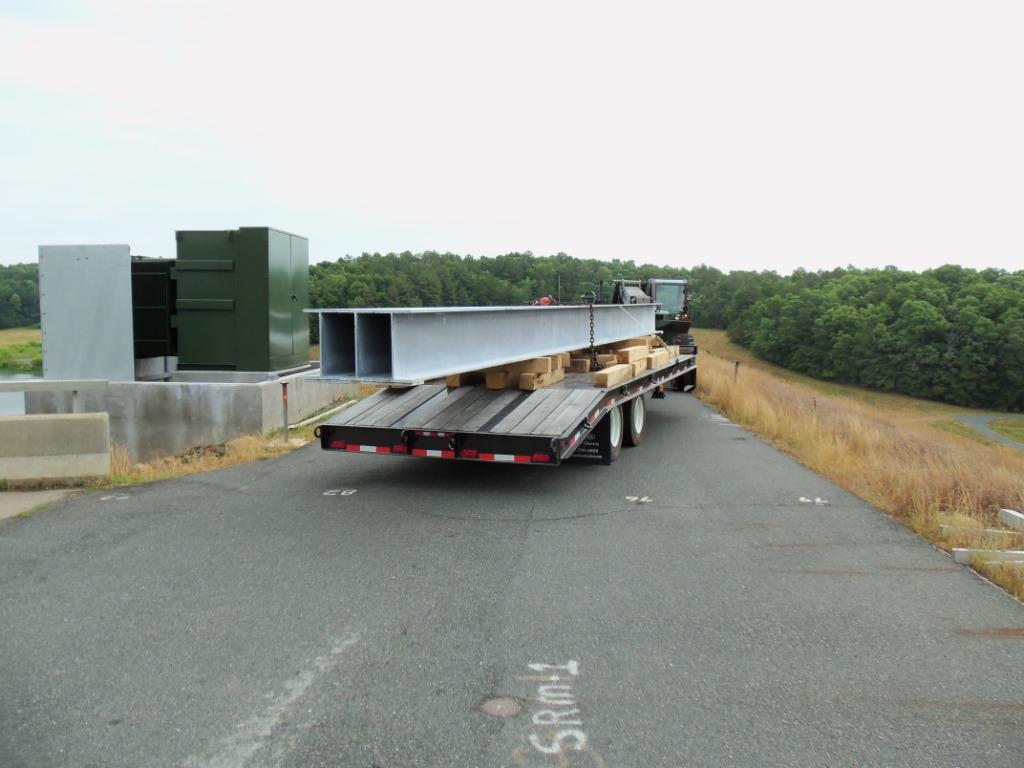

TRANSPORTING DOWNSTREAM OUTRIGGER SUPPORT BEAMS USING EQUIPMENT TRAILER AND 10K MLULL |
TIGHT TURN AT BRIDGE |

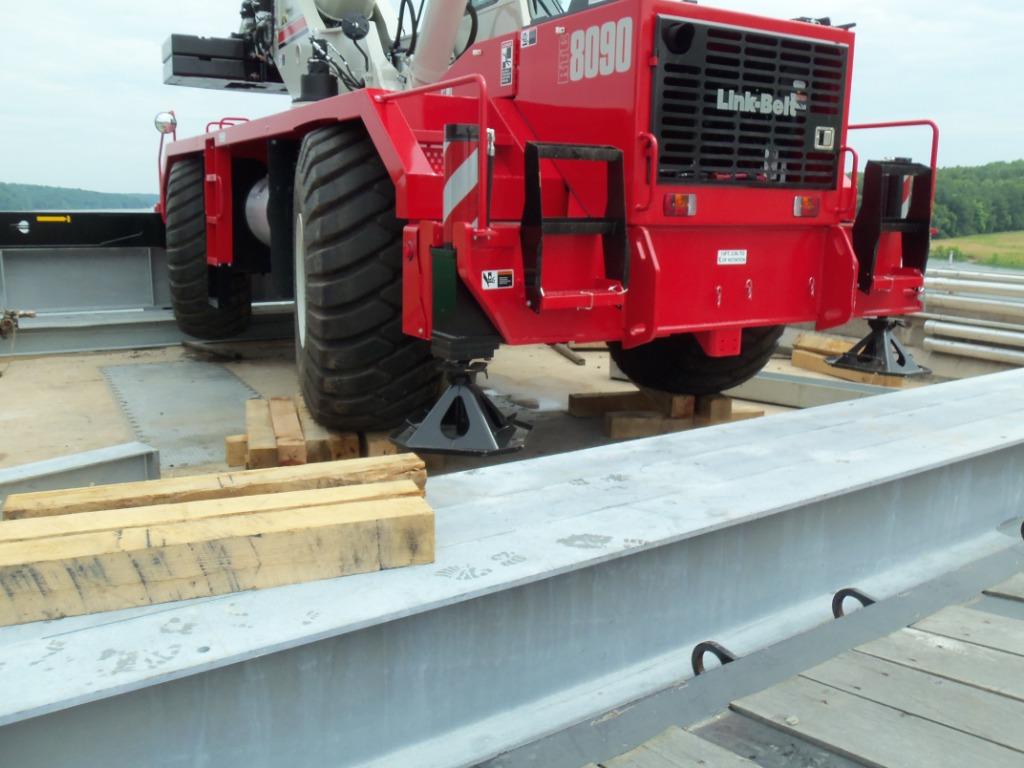

CRANE JACKED UP ON TIMBERS TO CLEAR SUPPORT BEAM FULLY RETRACTED OUTRIGGER ON CENTER ROOF BEAM FULLY EXTENDED OUTRIGGER ON SIDE WALL |

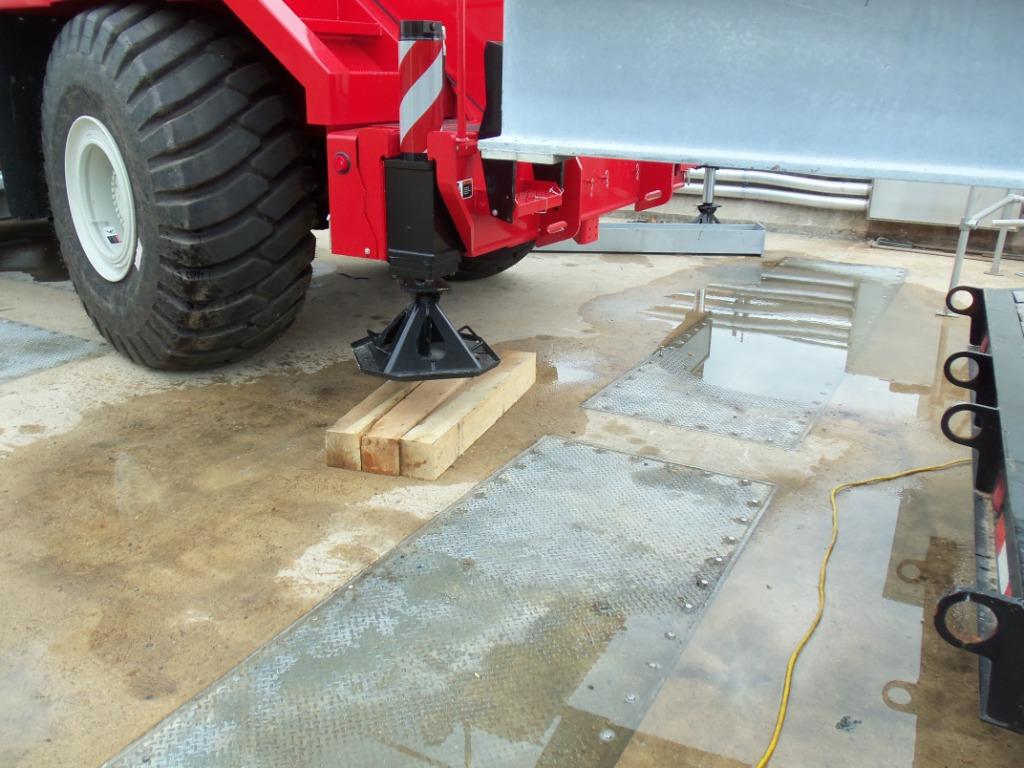

CRANE JACKED UP AND WOOD CRIBBING PLACED UNDER TIRES |

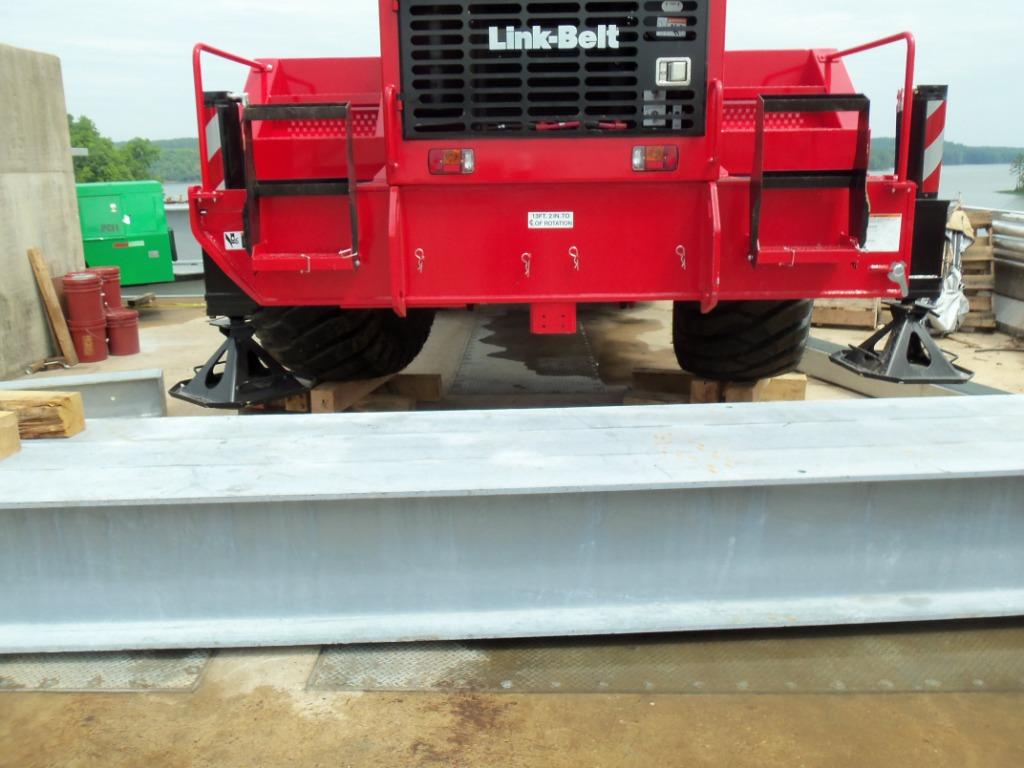

DS SUPPORT BEAMS PLACED DOWNSTREAM OF OUTRIGGERS PUSHED UNDER OUTRIGGERS BY MLULL FORKLIFT |

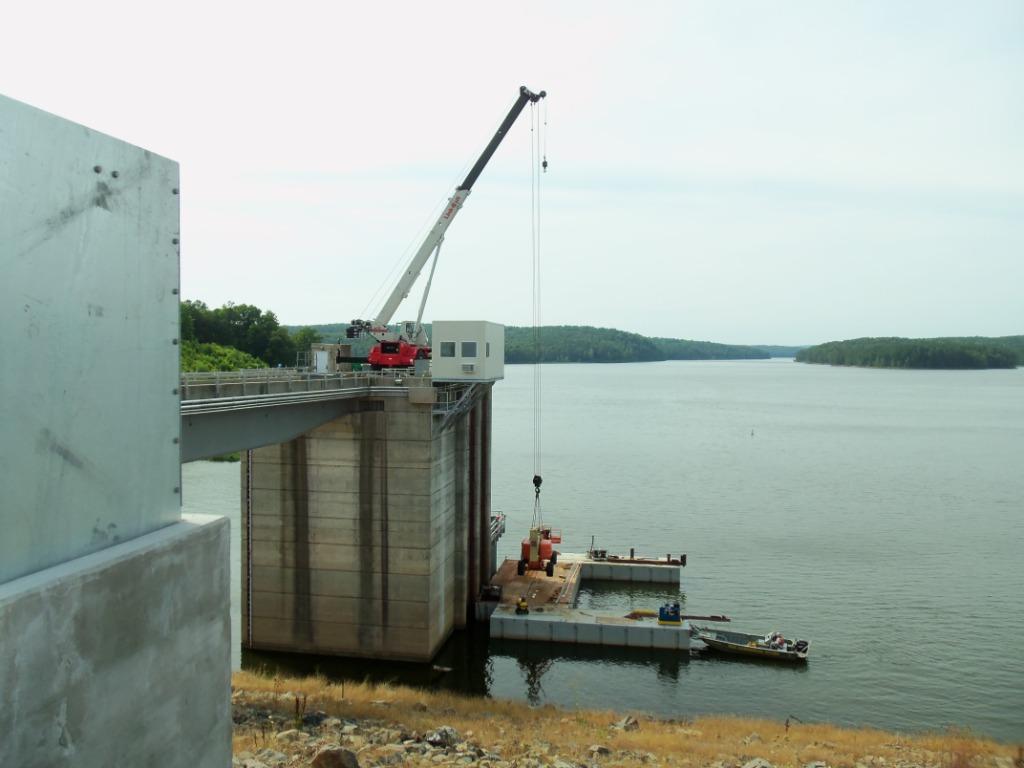

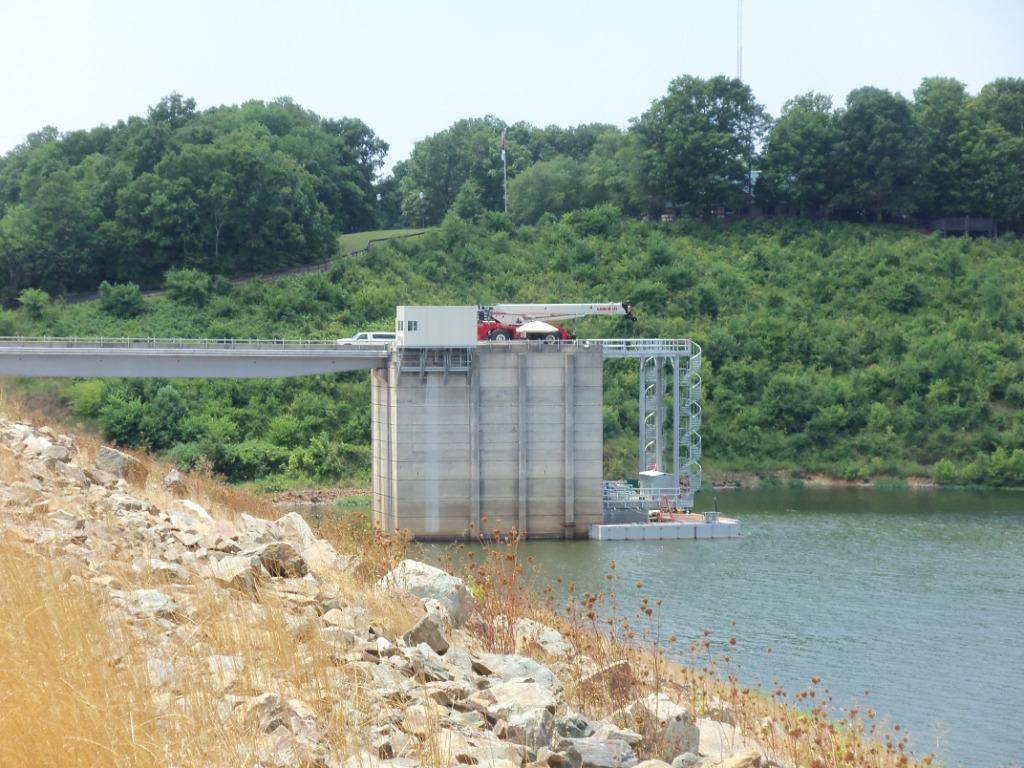

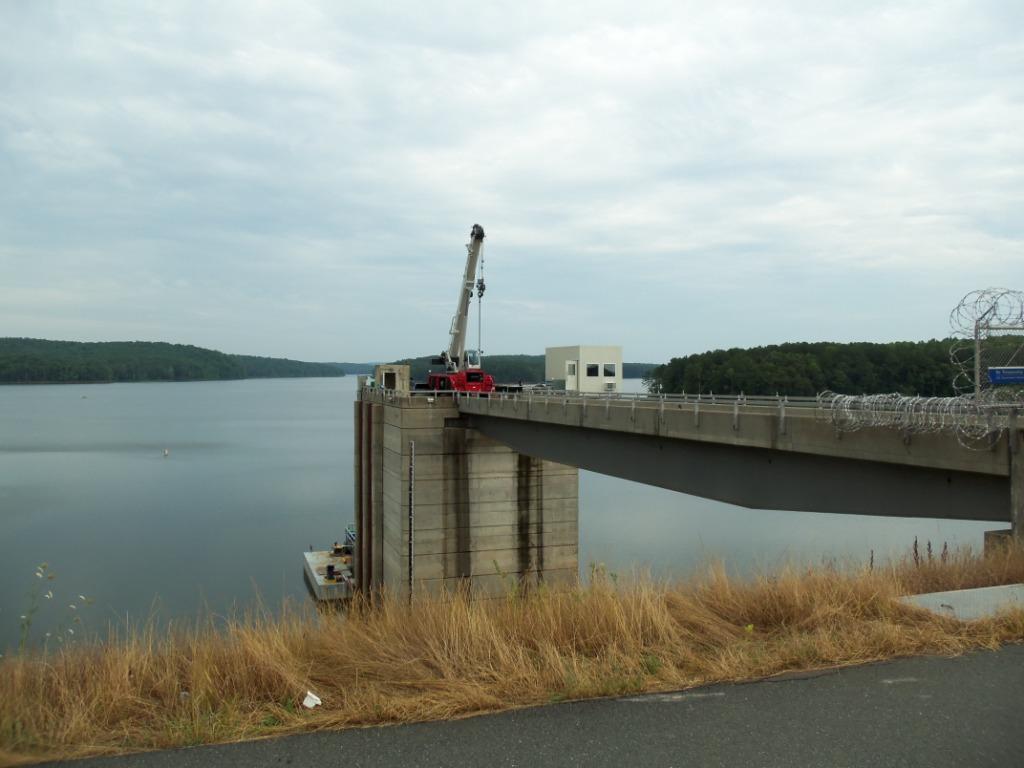

COMPLETED SETUP OUTRIGGER LOADS TRANSMITTED BY DS SUPPORT BEAMS TO SIDE WALLS |

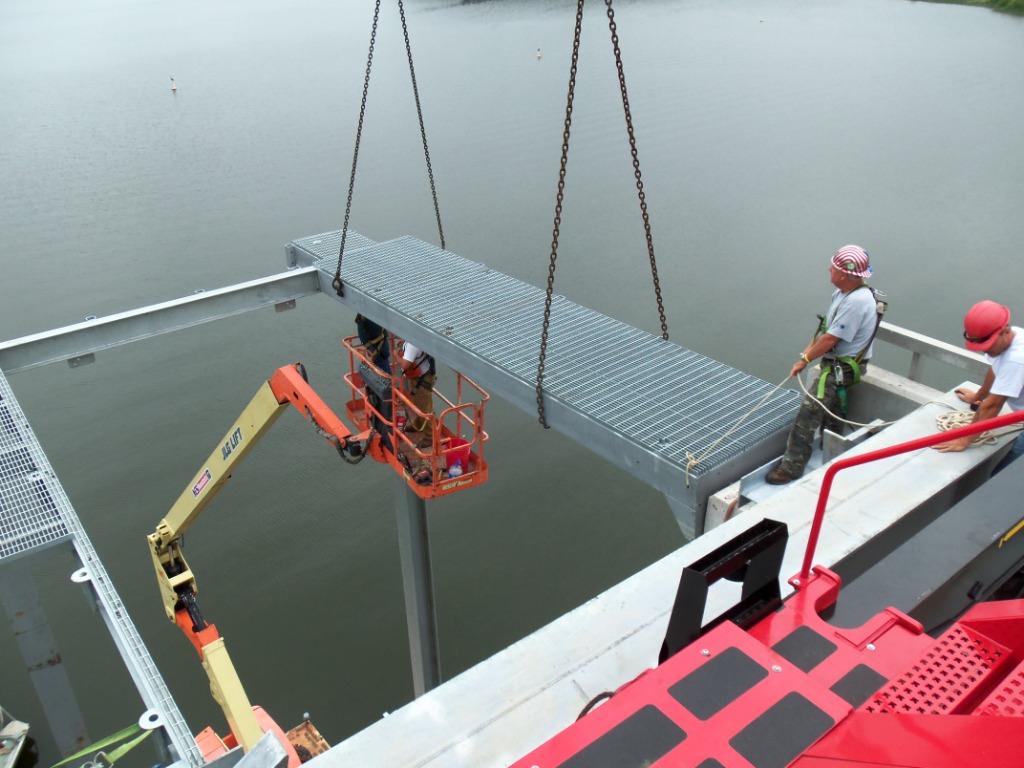

BARGE SECTIONS MOVED FROM FRONT OF TOWER TO EAST SIDE |

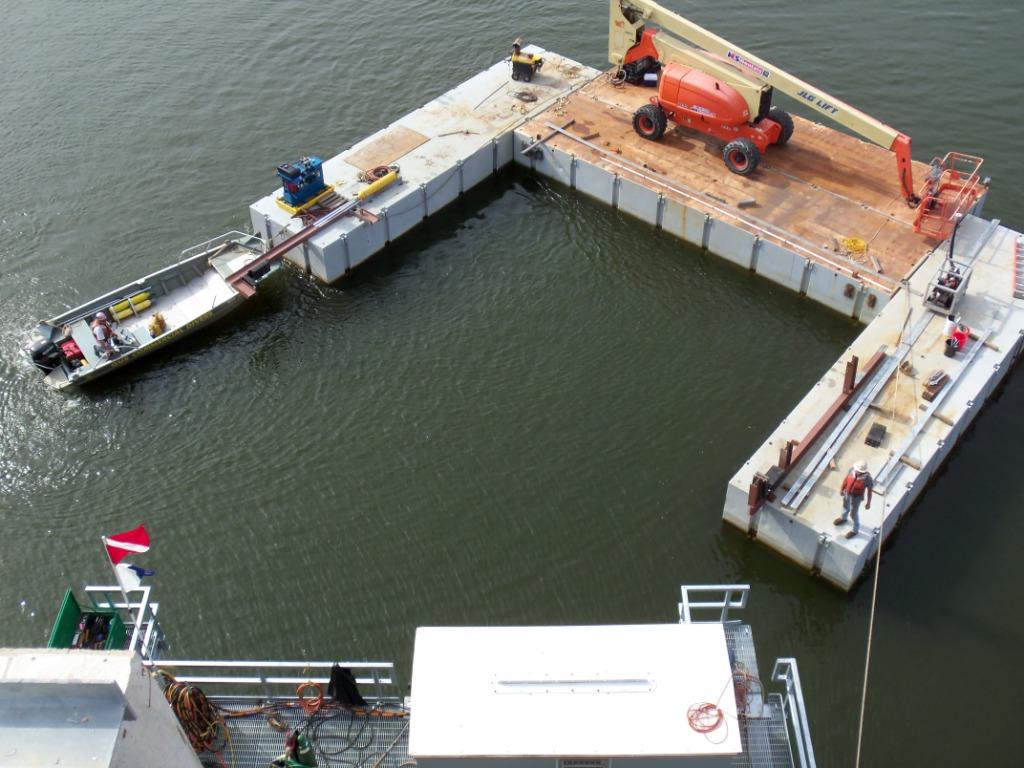

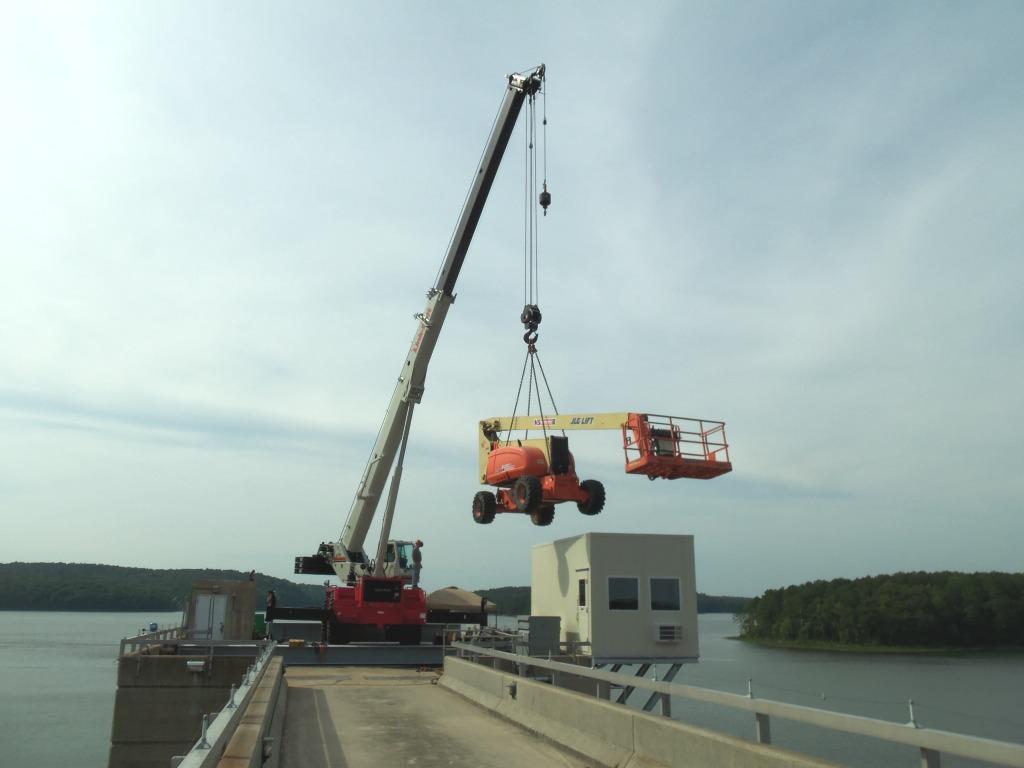

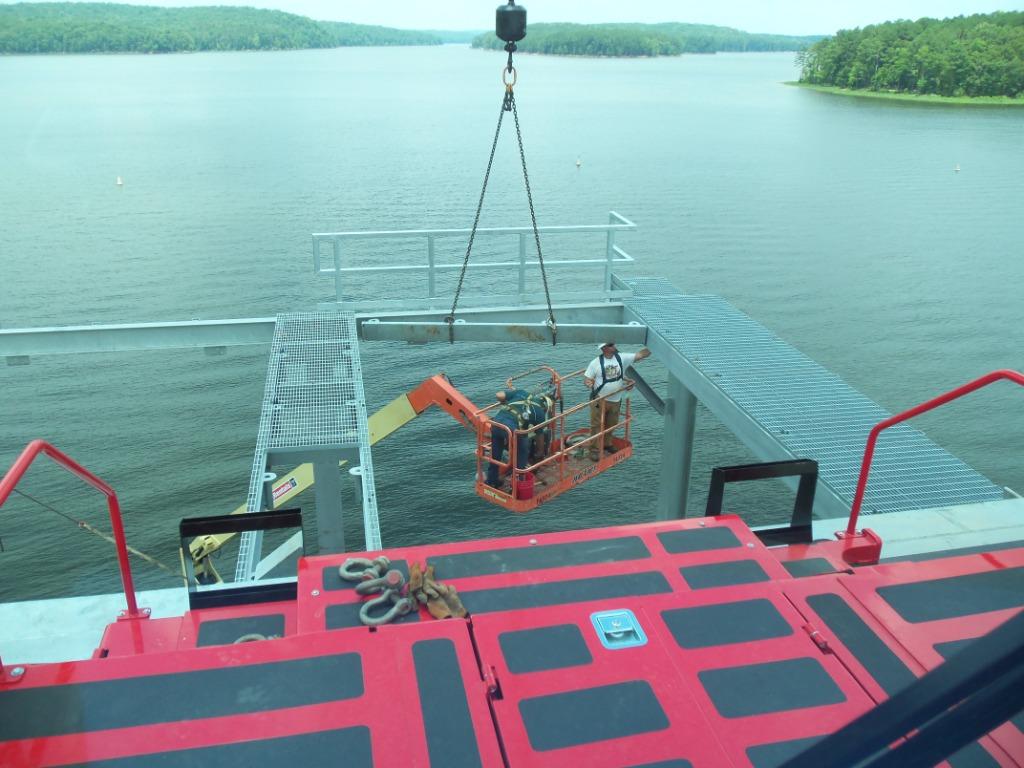

JLG 800A ARTICULATING PERSONNEL LIFT LOWERED ONTO BARGES |
|
BARGE WITH LIFT REPOSITIONED ON NORTH END OF TOWER |

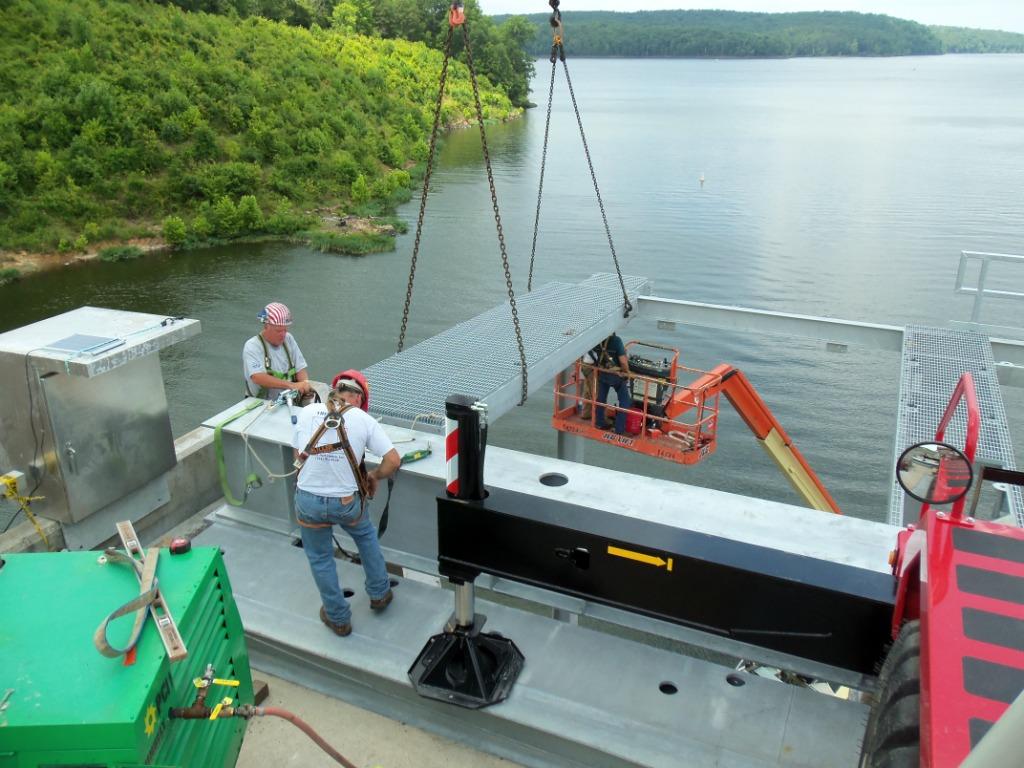

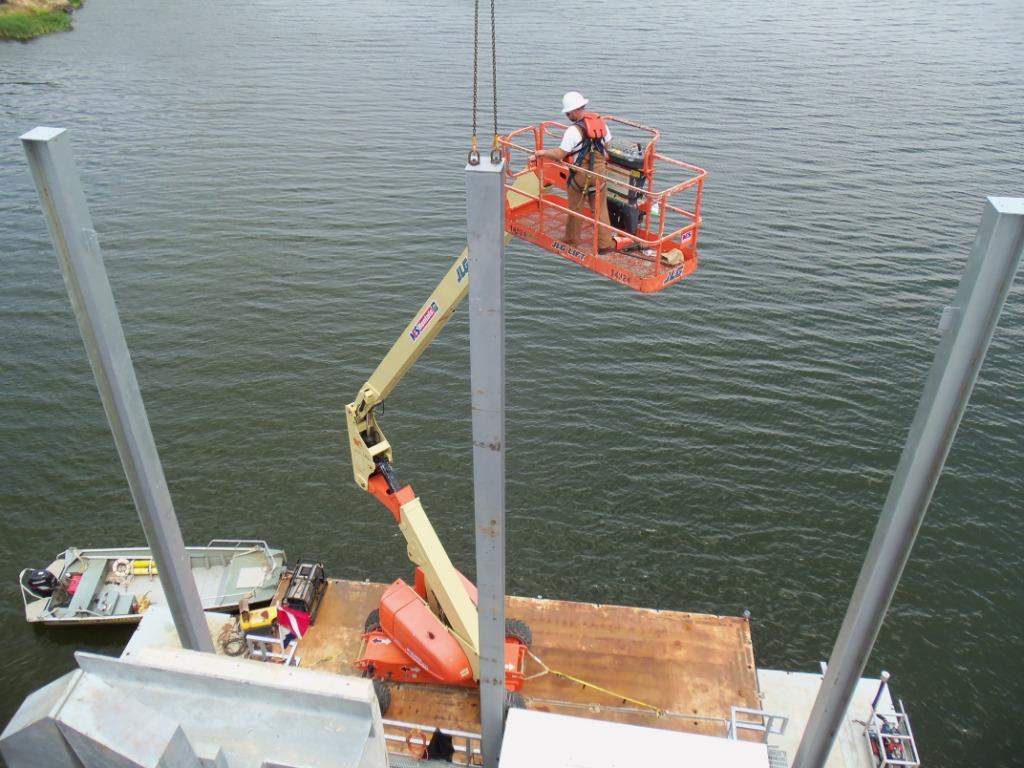

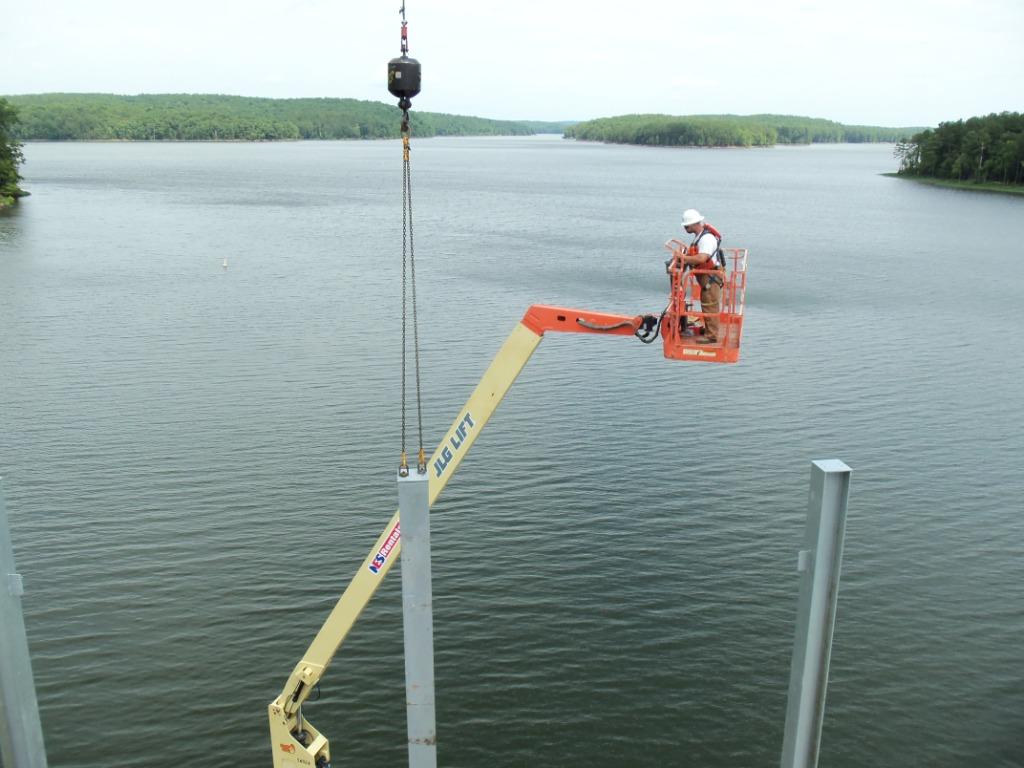

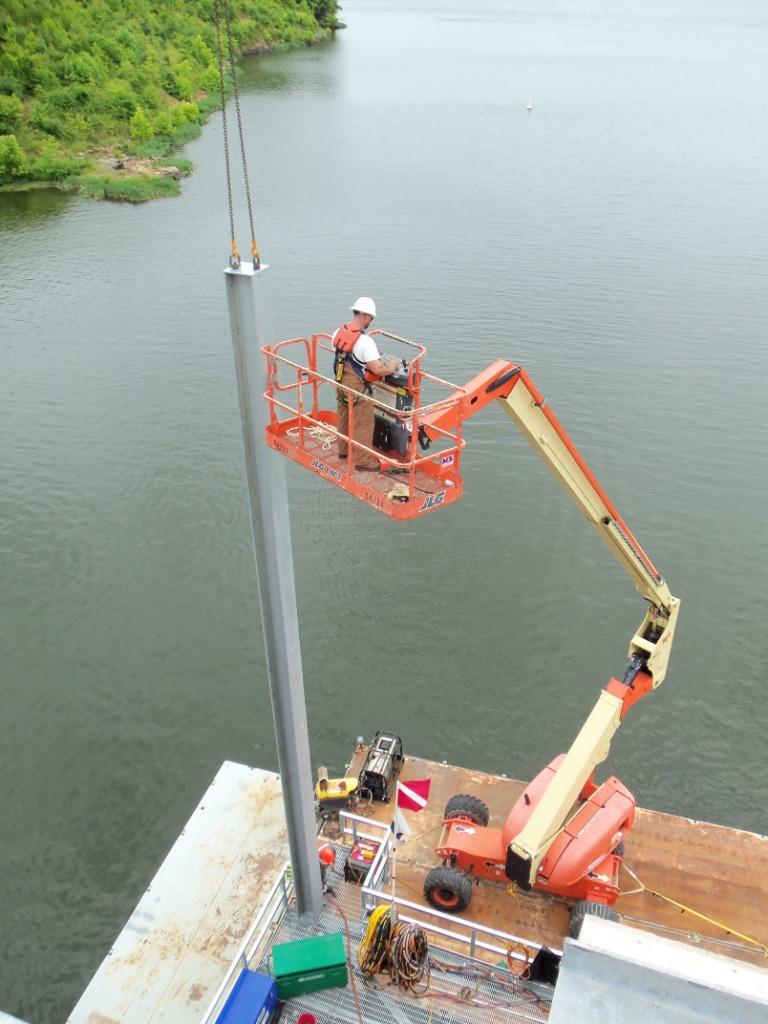

SETTING UPSTREAM SUPPORT COLUMNS |

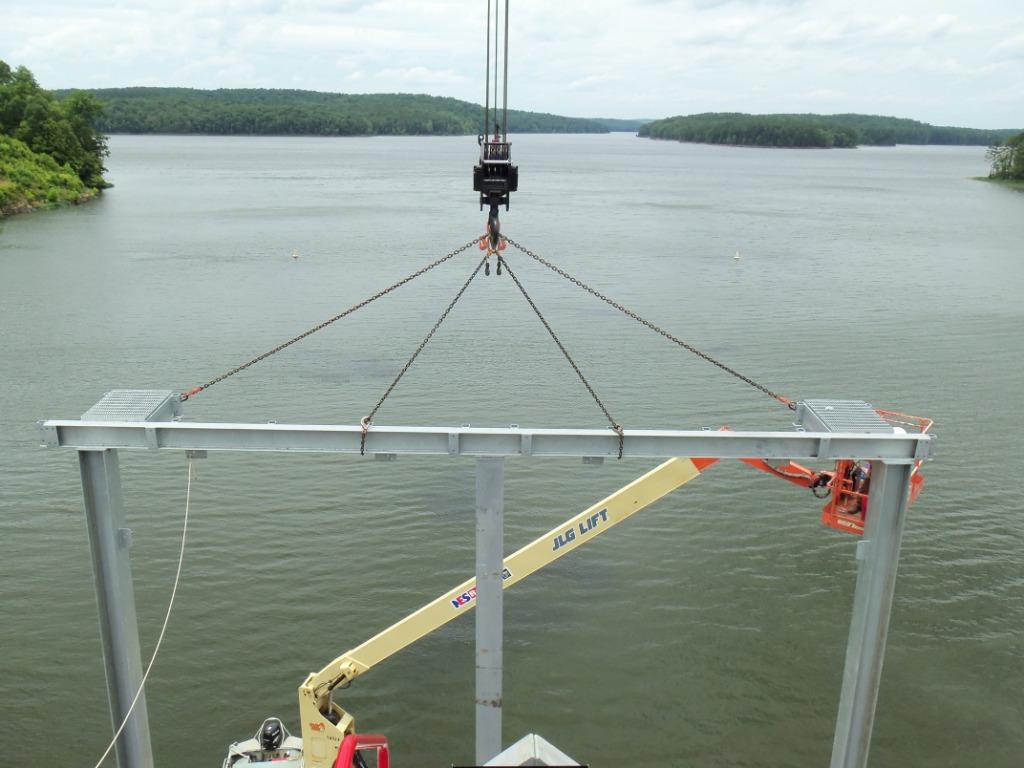

SETTING UPSTREAM SUPPORT BEAM |

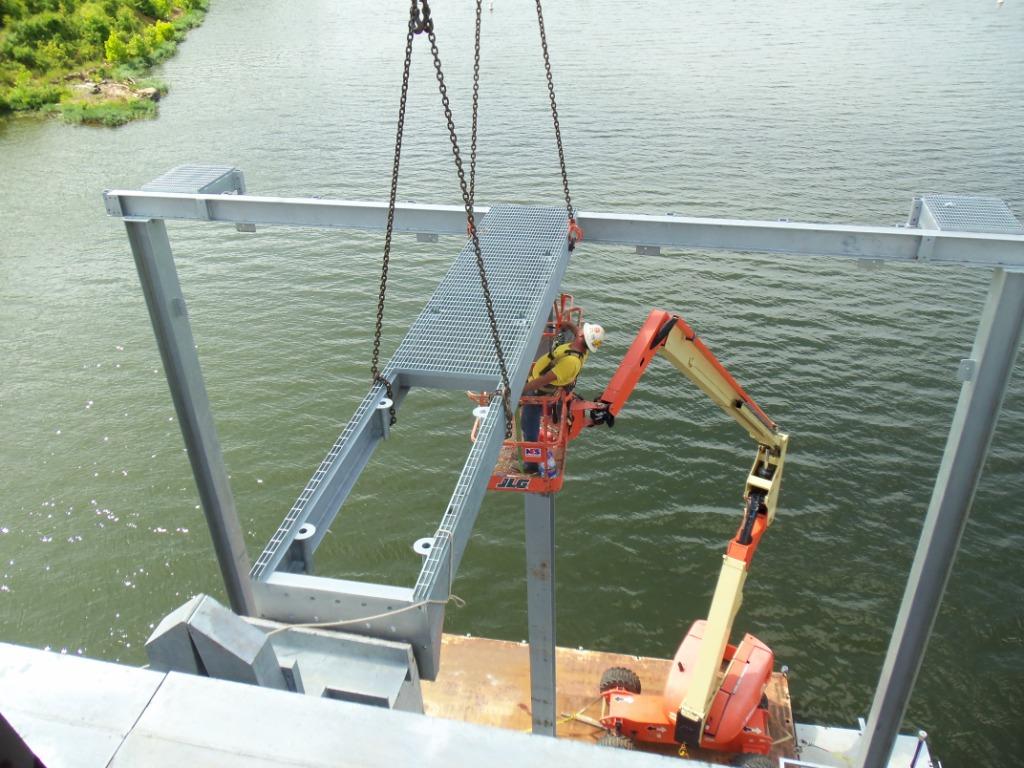

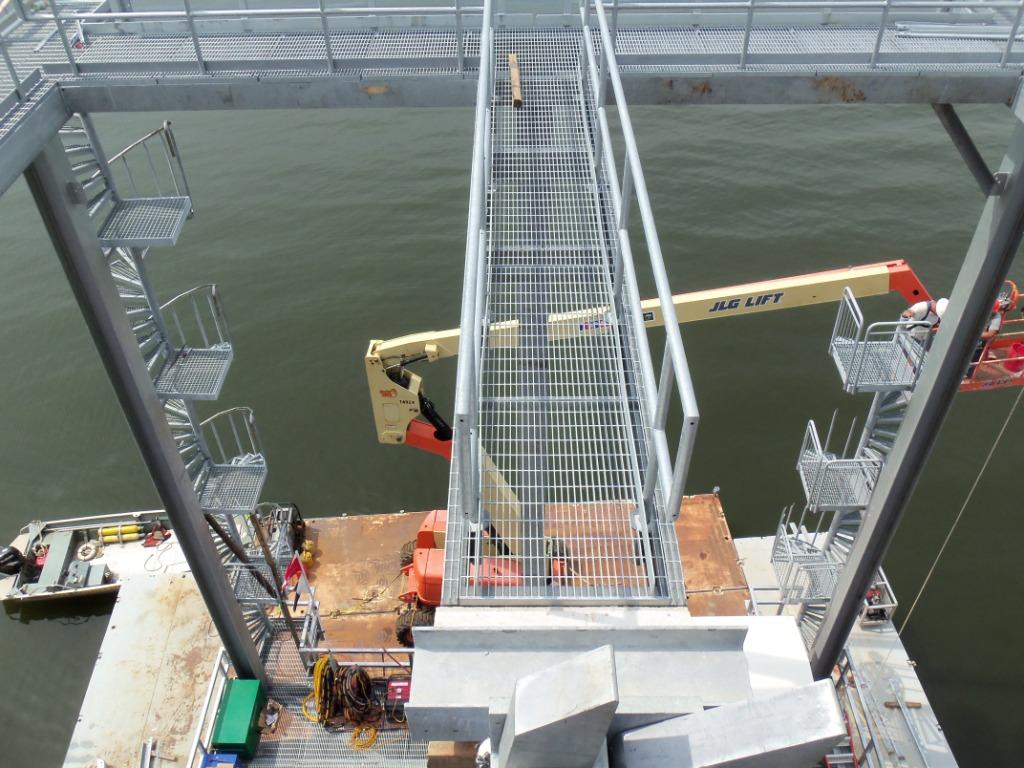

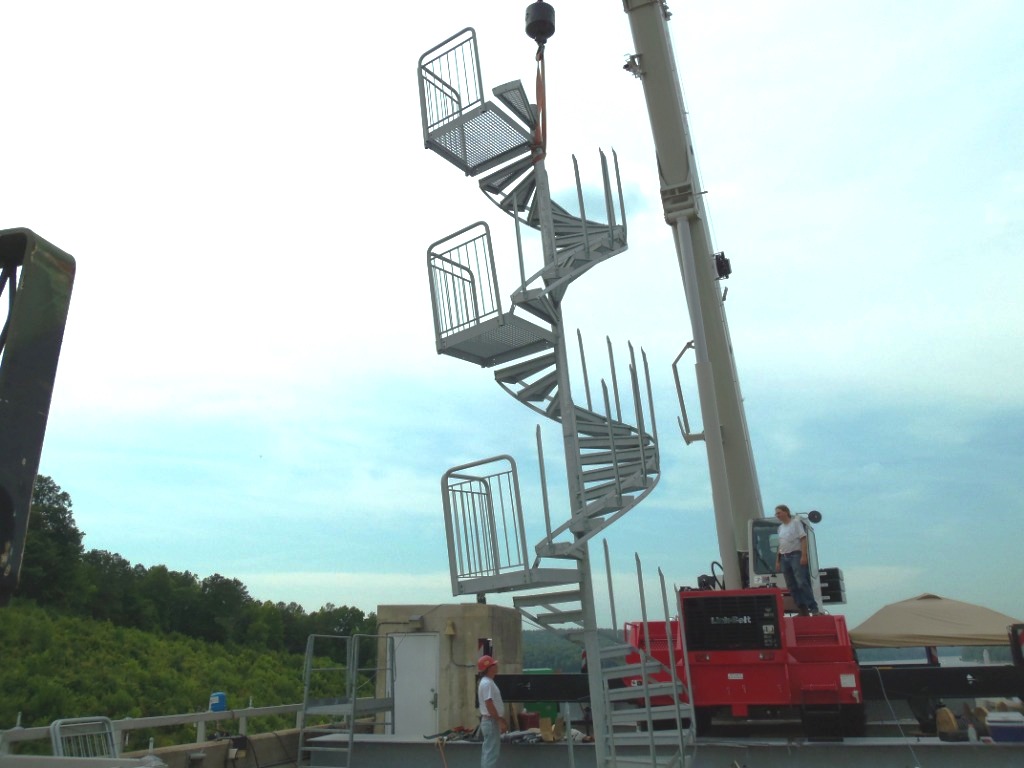

SETTING PLATFORMS |

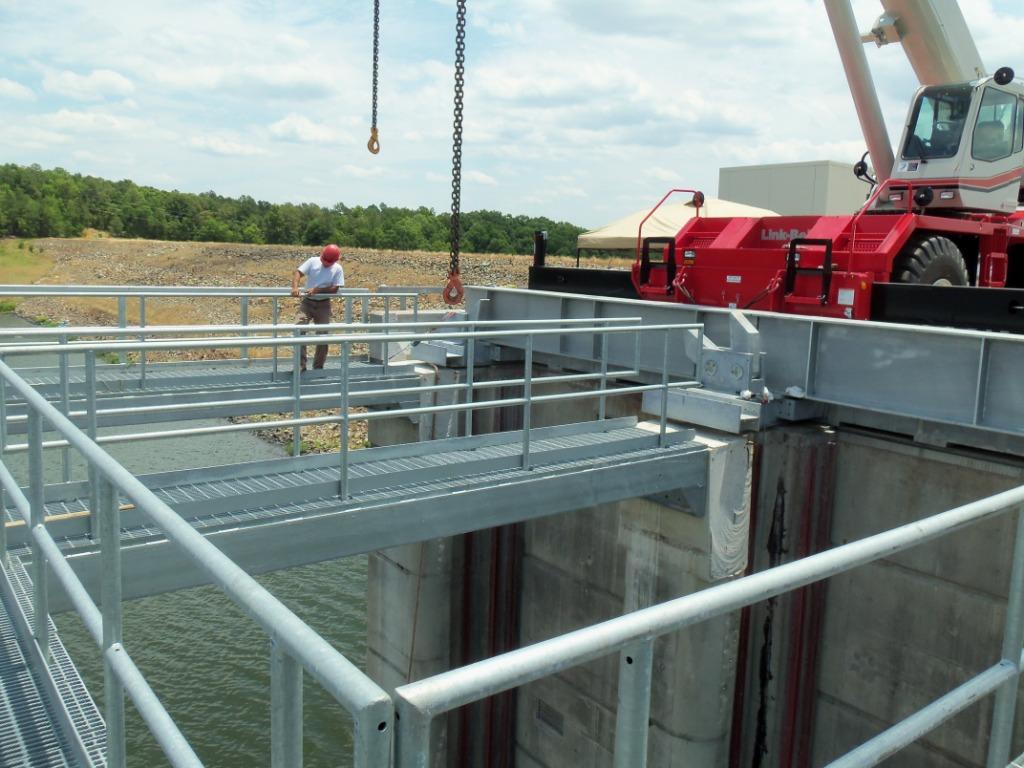

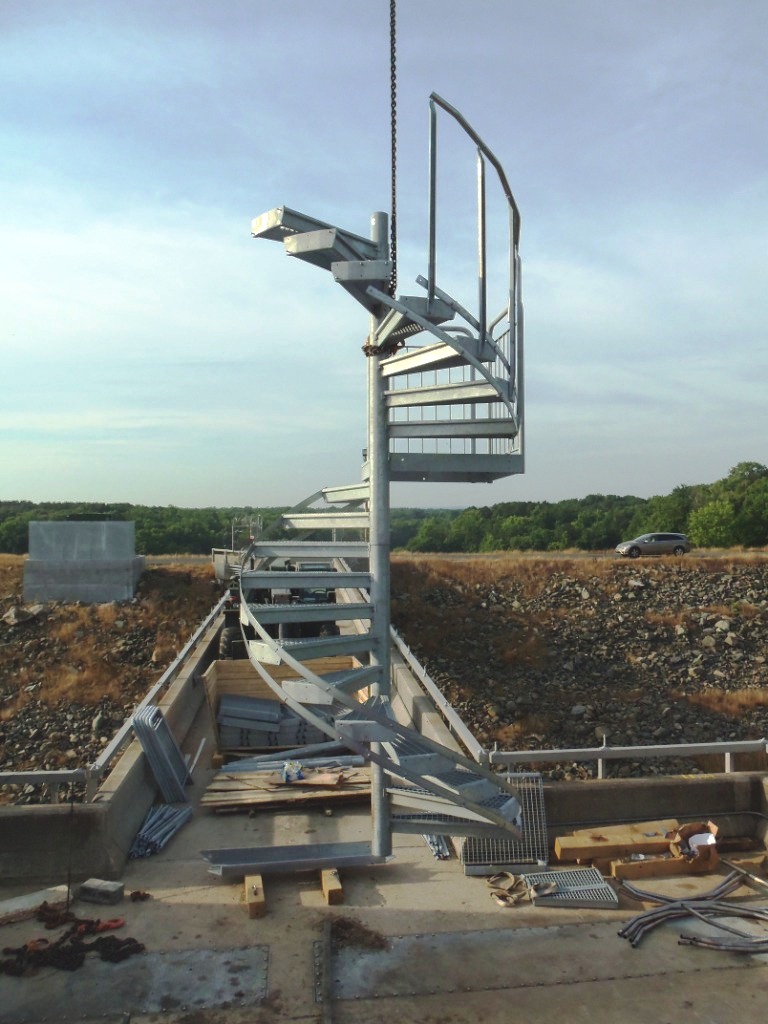

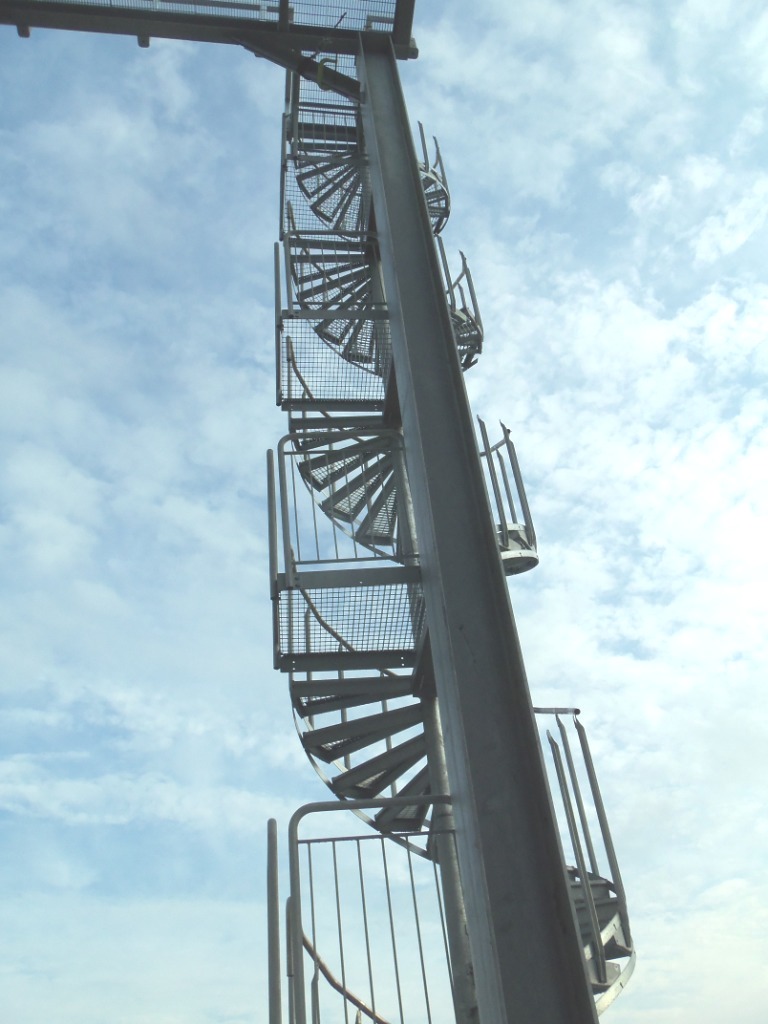

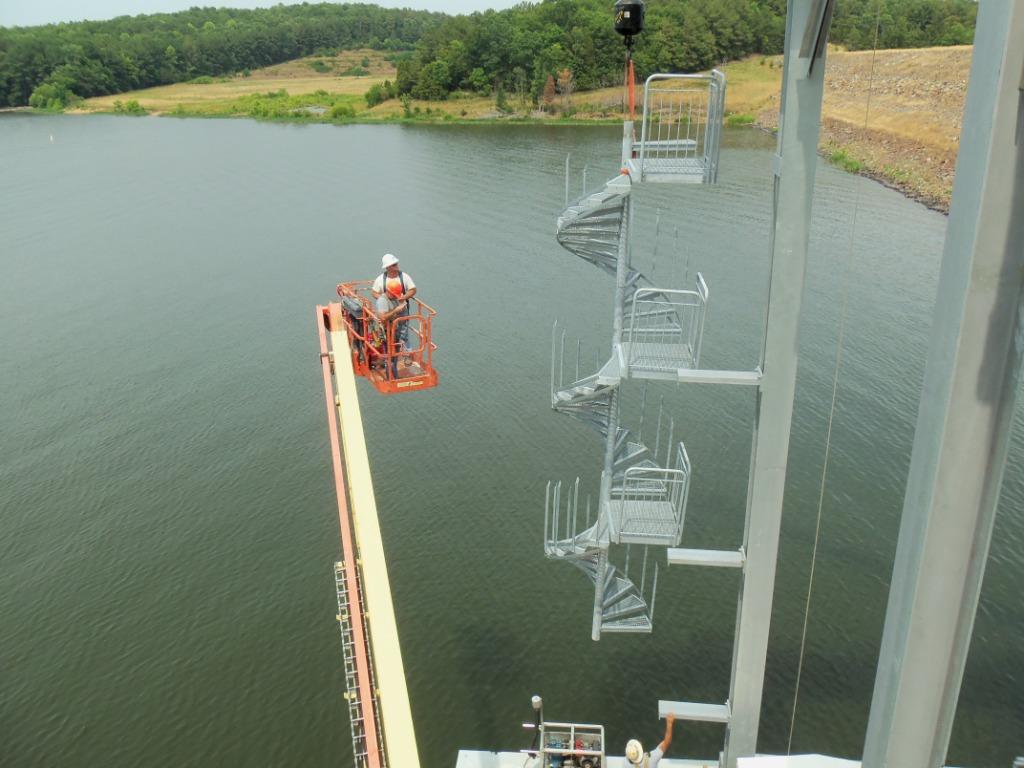

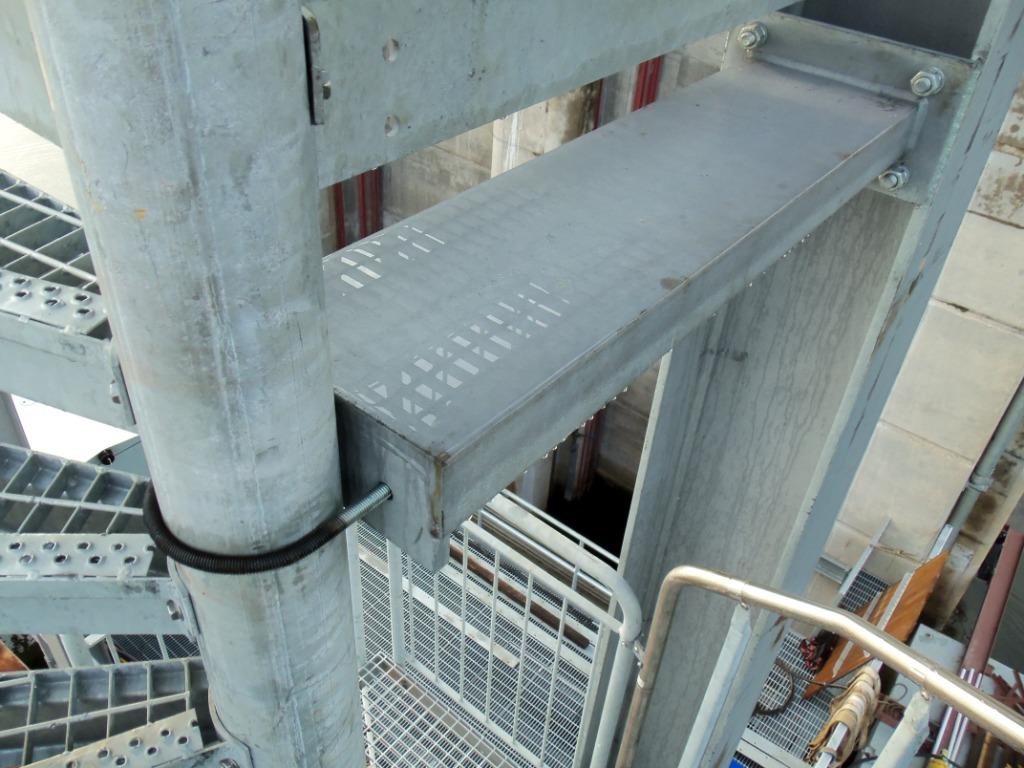

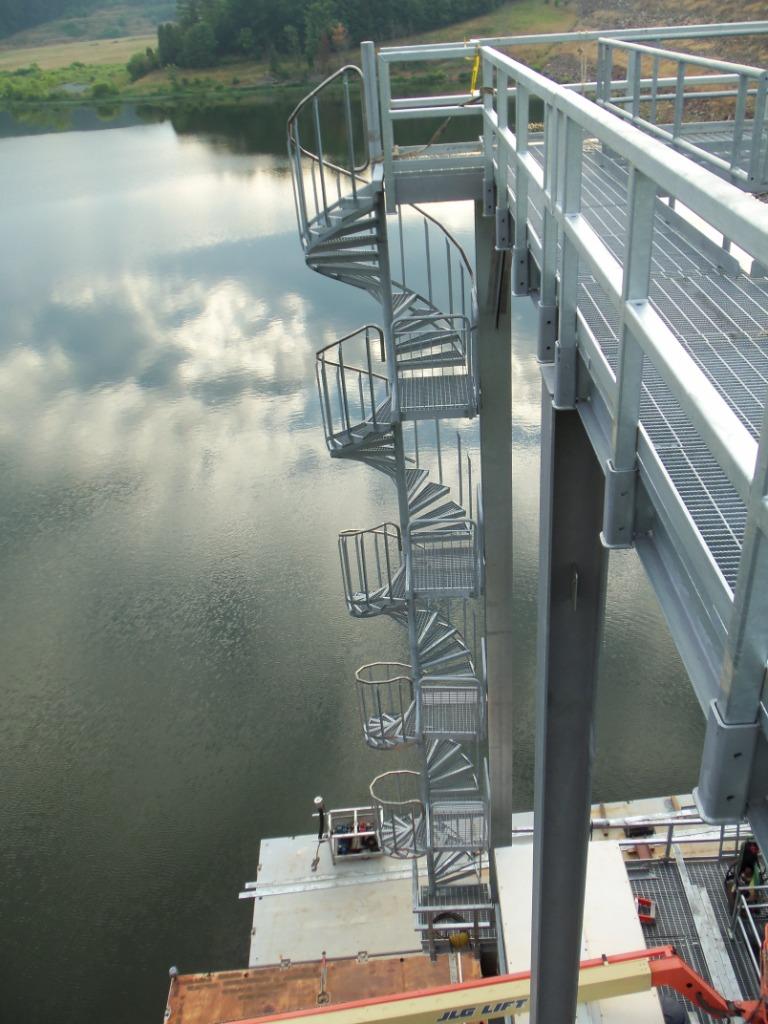

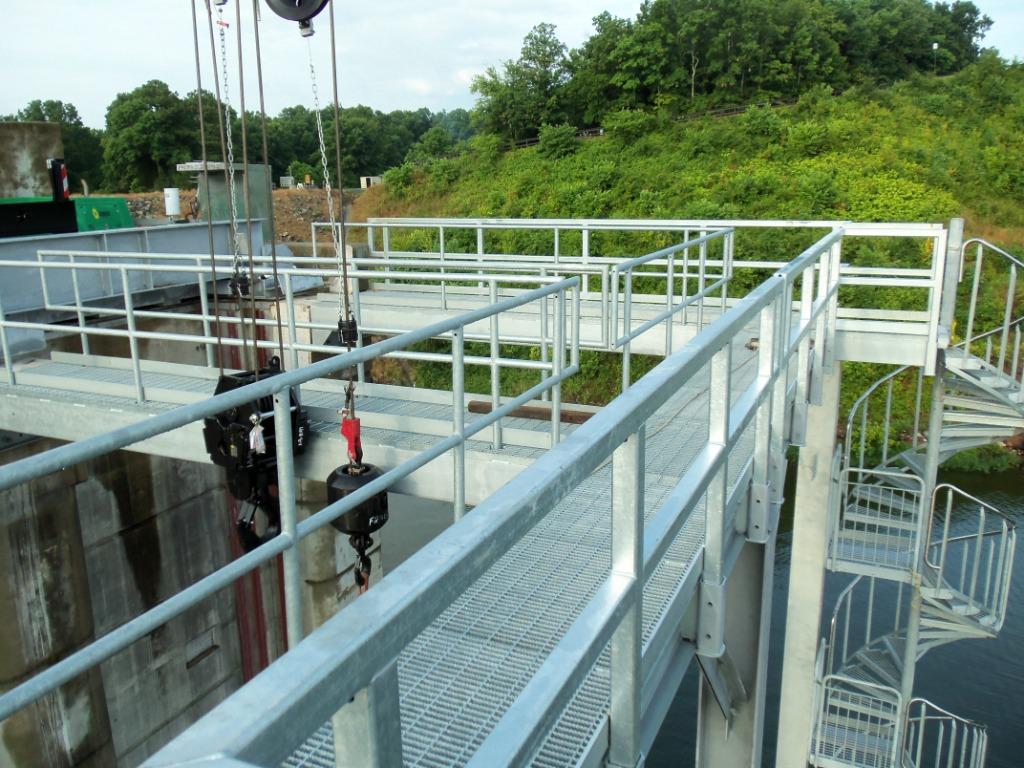

RAILS |
|

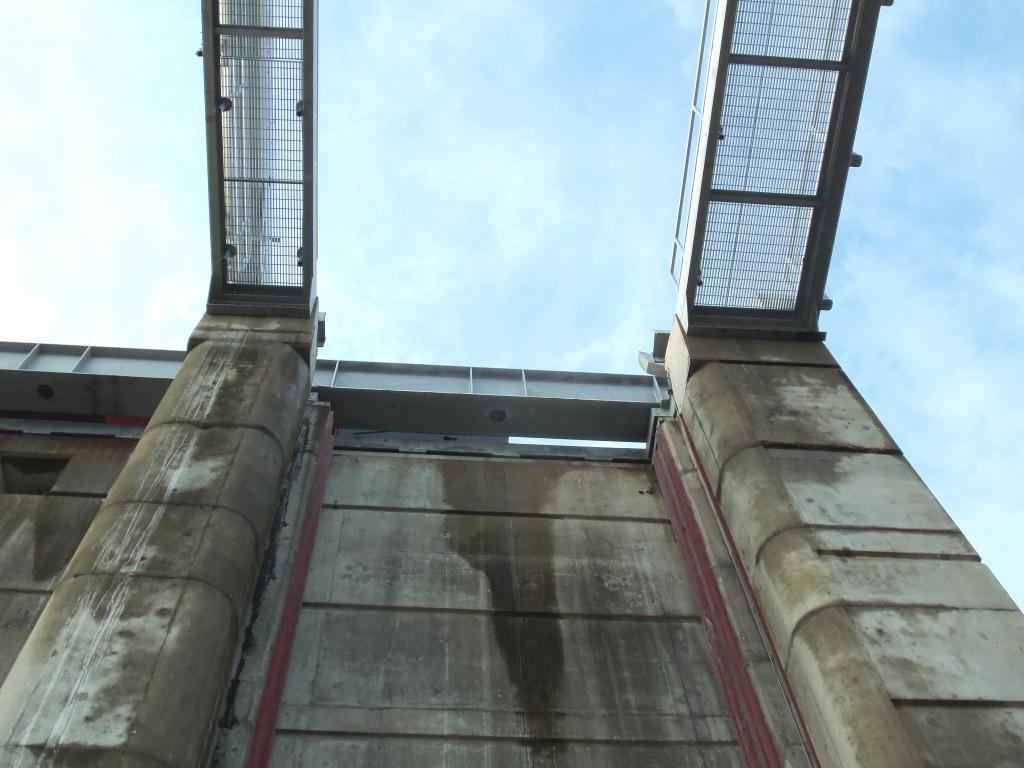

LOWER PLATFORM EAST SUPPORT BEAM |

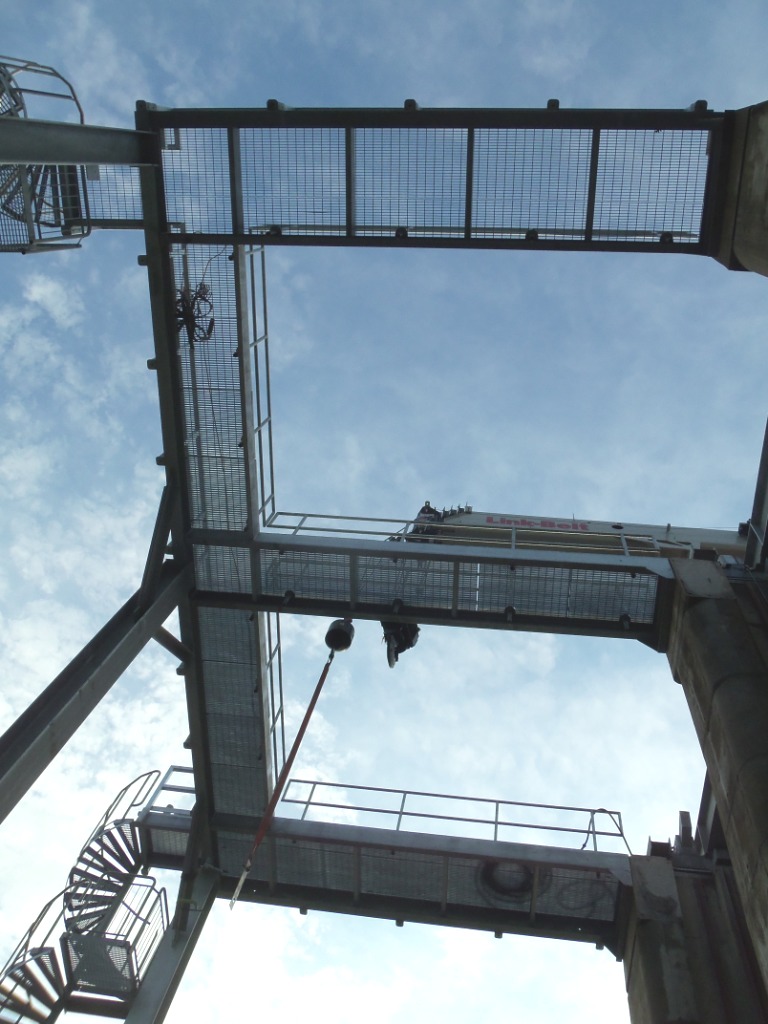

UPPER PLATFORM VIEW FROM BELOW |
|

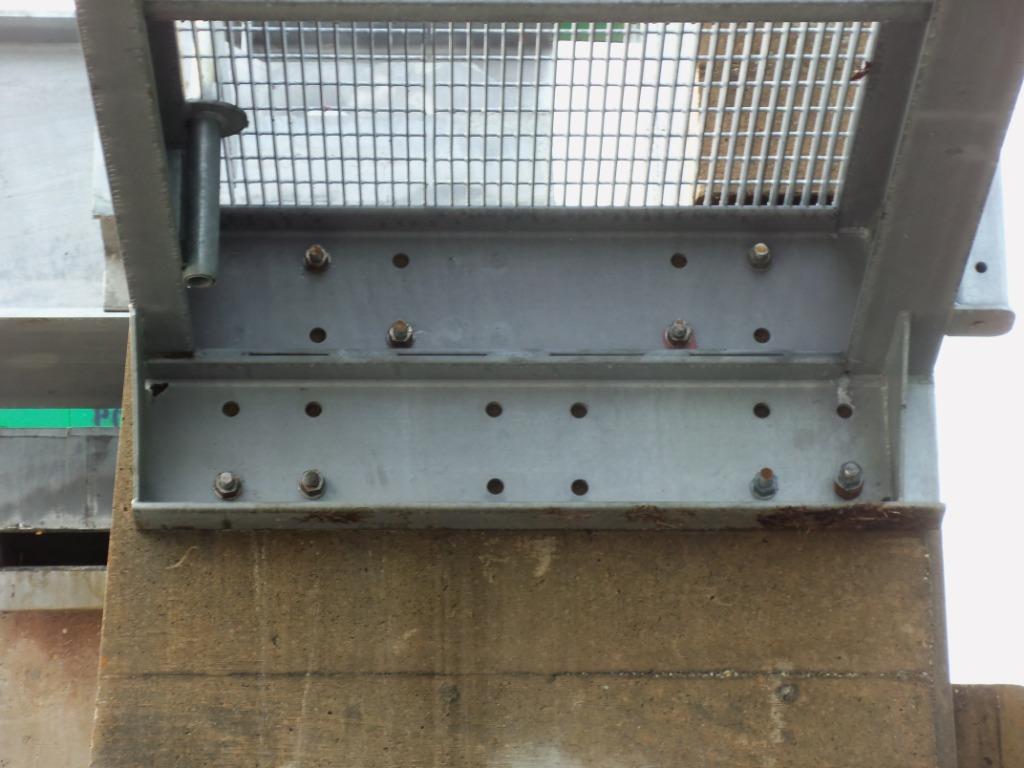

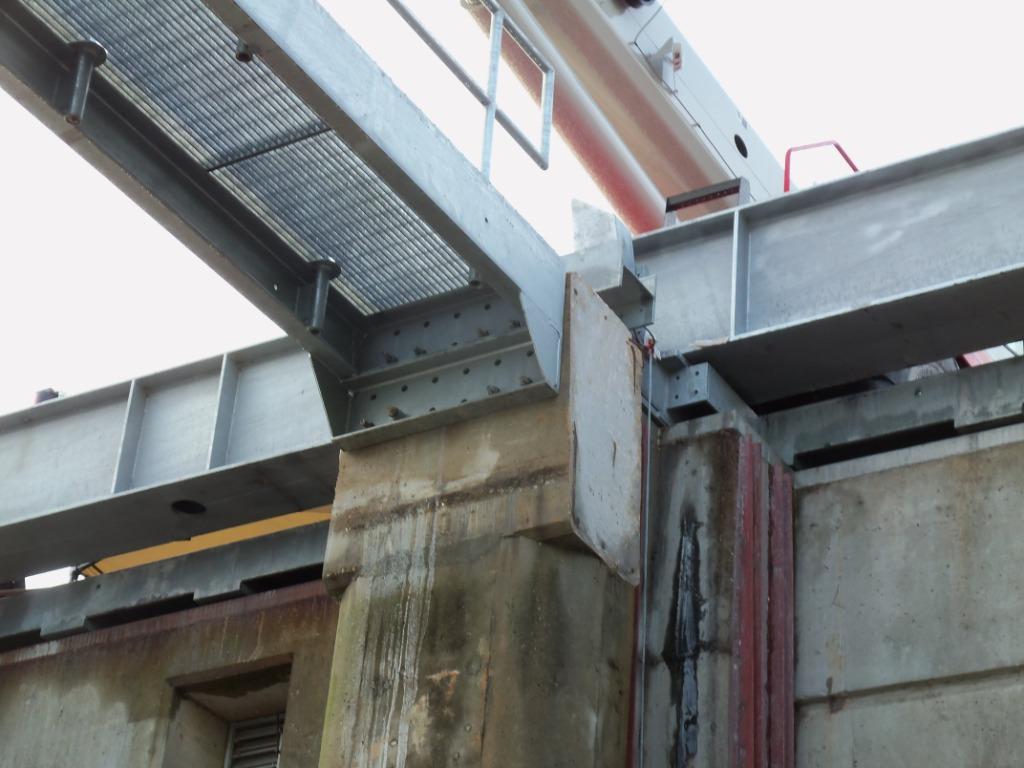

ANCHORING
